Flood Risk Management Scheme
Since 2012 the Environment Agency (EA) have worked with key partners, listened to and worked with the local community to generate a flood risk management scheme to reduce the risk of flooding in both Littleborough and Rochdale. Technical feasibility, economic viability, environmental sustainability and social acceptability were all considered when deciding on a preferred option.
The Phase 1 (Littleborough) and Phase 2 (Rochdale) schemes have the following associated benefits:
- Phase 1 – Reduced frequency and consequence of flooding with 337 homes and 185 non-residential properties better protected from flooding.
- Phase 2 – Reduced frequency and consequence of flooding with 386 homes and 304 non-residential properties better protected from flooding.
- Reduced risk of blockage at key restrictions.
- Reduction in whole life carbon emissions because of reduced flooding of property.
- Biodiversity net gain and habitat improvements.
The scheme is led by the Environment Agency in partnership with Rochdale Borough Council. The scheme is funded by Government Flood Defence Grant in Aid (FDGiA) with contributions from, Network Rail, the North West RFCC, Transport for Greater Manchester, and the Departments for Education and Transport.
The planning application for Phase 1a including the enabling works was submitted to Rochdale Borough Council in January 2020 and was granted in May 2020 subject to planning conditions. The planning application can be viewed on the Rochdale Borough Council Website: https://publicaccess.rochdale.gov.uk/online-applications/applicationDetails.do?keyVal=Q4RTQPNBHTM00&activeTab=summary
The planning application for Phase 1b including the enabling works was submitted to Rochdale Borough Council in April 2022 and was granted in July 2022 subject to planning conditions. The planning application can be viewed on the Rochdale Borough Council Website: https://publicaccess.rochdale.gov.uk/online-applications/applicationDetails.do?activeTab=externalDocuments&keyVal=RA0S2JNB00700
Gale Enabling Works
The construction of the accesses was crucial to the enabling works which saw Network Rail install a new culvert under the Calder Valley railway line. This culvert is a critical new asset for the future flood storage reservoir planned for the Gale site (Phase 1b) which will hold water back and slow the flow of the River Roch and Greenvale Brook into Littleborough town centre.
The access ramp into the Gale West site also enabled the Phase 1a & 1b site compound to be established and will allow the construction of the flood storage reservoir.
Phase 1A (Littleborough)
This phase consists of the following work packages related to various locations within Littleborough. With the exception of the Enabling Works package, these works began in Early 2022. The works undertaken were:
Riverstone Bridge – Demolition of existing road bridge and footbridge and replacement with a combined road and footbridge, river channel widening and associated landscaping works.
Charles Street – Removal of existing bridge over the River Roch due to causing a constriction to flood flows in the river. Erection of infill wall to close the gap with wall mounted railing and associated landscape works.
Peel Street – Modification of existing flood wall to raise the height and associated landscape works.
Town House Brook – Raising of existing flood defence wall, installation of coarse trash posts, raising and extension of pedestrian ramp and associated landscape works.
Carriage Drive – Bank repairs to re-instate channel width and removal of debris in the existing culverts.
Phase 1B (Littleborough)
This phase comprises of the construction of a flood storage reservoir at the Gale site just off Todmorden Road. This phase comprises of the following work packages:
Grove Lodge – Construction of a flood defence wall along a rail embankment, habitat and footpath improvements.
Reddyshore Brow – Bank reinforcement, erosion control works to private gardens and waterproofing to private houses.
Gale West –. Construction of earth embankments and sheet pile walls to form a flood impounding structure. In addition, the construction of a flow control structure, maintenance track and access track, installation of CCTV, telemetry kiosk, railings and gates.
Gale East – Construction of an earth embankment and diversion structure to create a flood water impounding structure.
Central Vale and Greenvale Business Park – Reinforced earth flood defence embankments and sheet pile flood defences within Greenvale Business Park.
Ealees Brook – Construction of sheet pile walls along south side of channel and landscape reinstatement works.
GNG Foam Converters – Service diversions required prior to Phase 1b works comprising construction of new flood defence wall in place of existing brick boundary wall.
Reservoir operation and safety
Phase 2 (Rochdale)
Initial designs for Rochdale Phase 2 have been completed and the main detailed design study is expected to start in Spring 2026. The Environment Agency look forward to engaging with residents, partners and businesses in the area once proposals have been developed further.
The proposals include flood storage at two sites (land upstream of Albert Royds and land downstream of Smithy Bridge Road). Additionally, raised flood defences are required along sections of the River Roch and Buckley Brook.
The Environment Agency are working to develop a viable design for the scheme and to unlock funding. The Environment Agency will work closely with Rochdale Borough Council and other partners to progress as quickly as possible.
What's Happening Now?

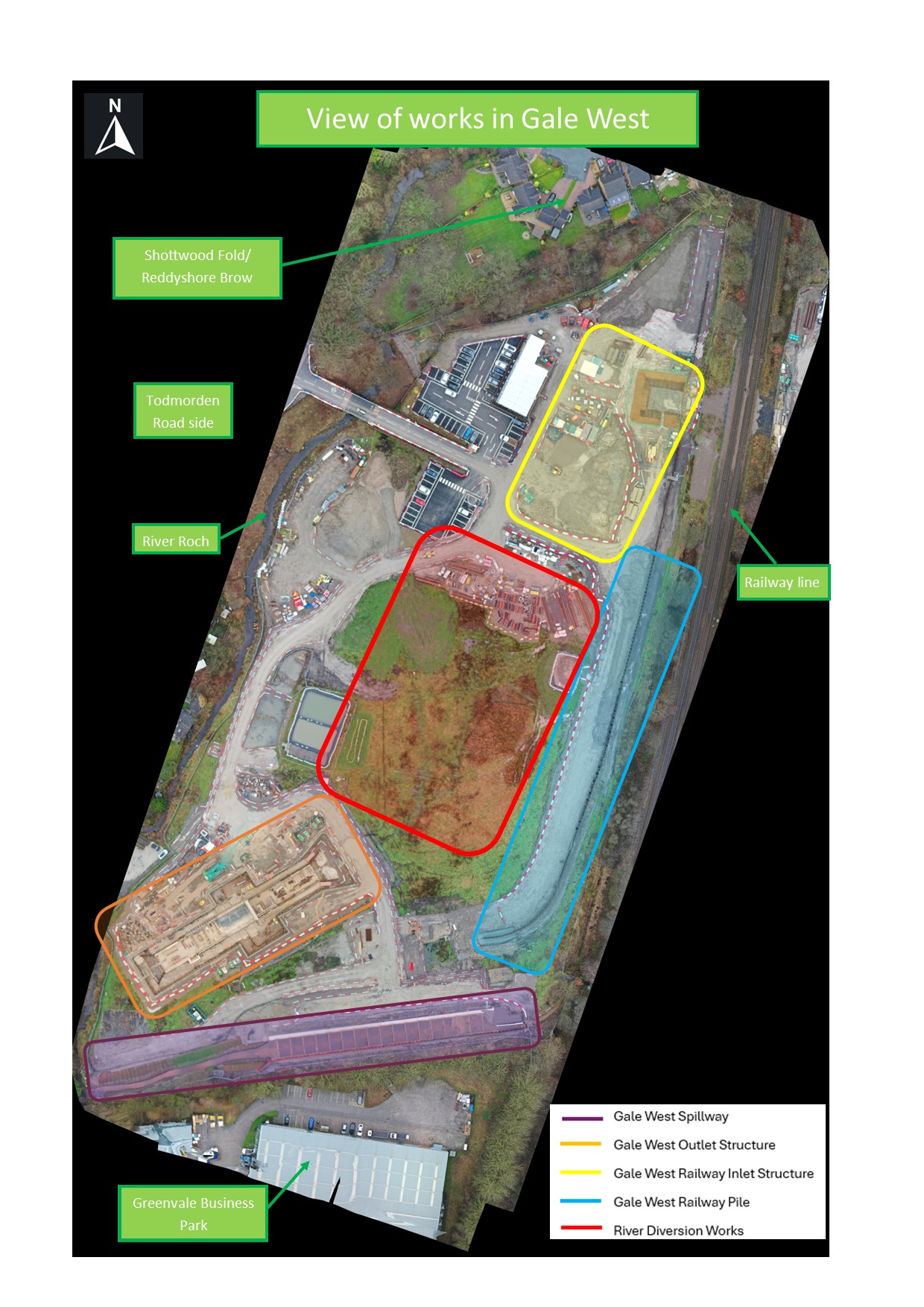

Map
March 2026
Gale West
Works to construct the scheme have now recommenced following a planned winter shutdown, which was required due to unsuitable weather conditions for earthworks. The team will be progressing the embankment construction and associated earthworks needed to build up the flood basin. In addition, the infilling of the former River Roch channel can continue now that flows have been fully diverted into the newly constructed channels.

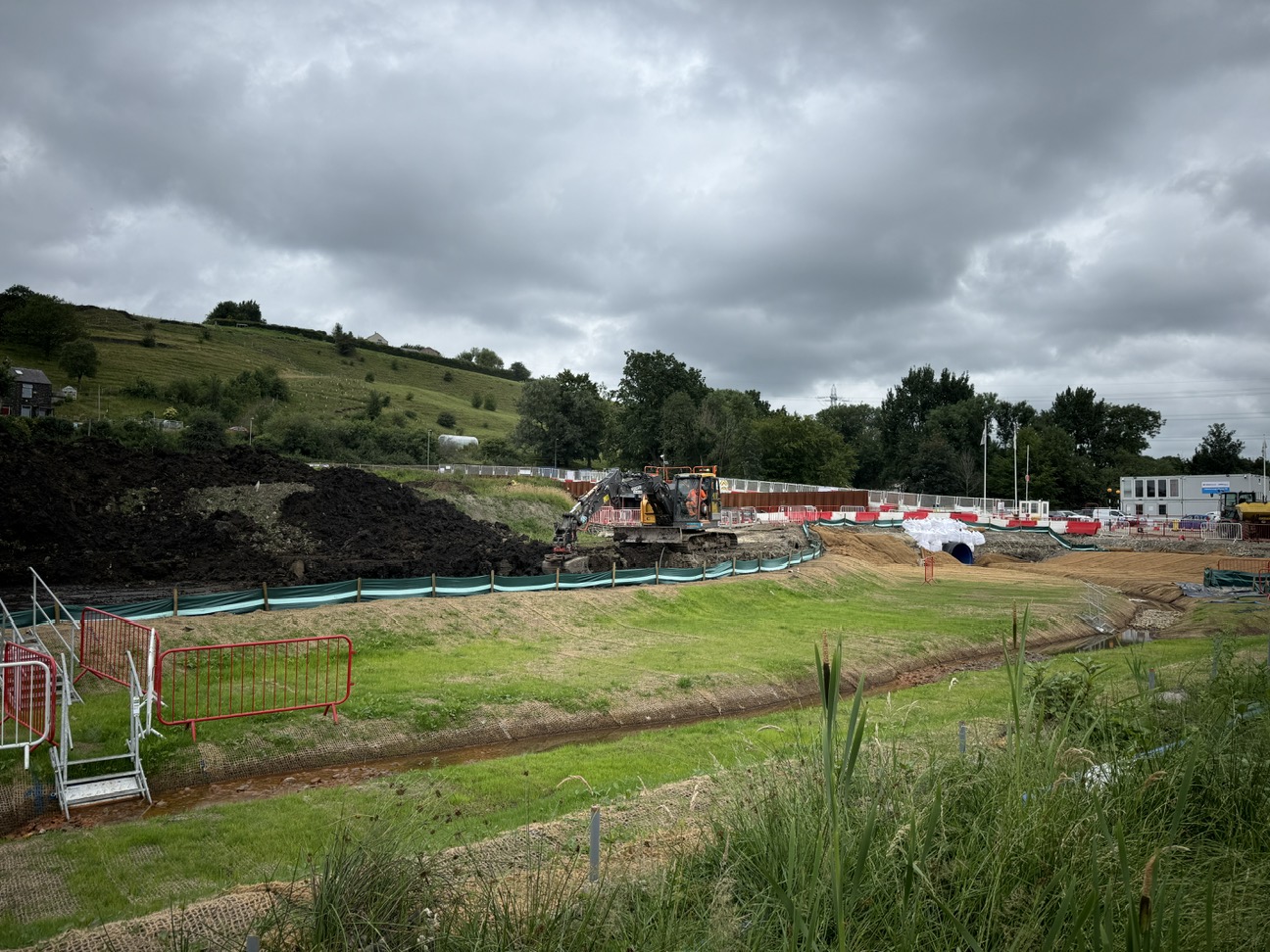

Silt management continues to be undertaken. Additionally, a Visqueen cover (see photo below) has been placed on the south embankment to help reduce the chance of material from the banks washing out into the watercourse.
On Todmorden Road, exploratory digs have recently been conducted to locate utility services on the pavement. This required temporary footpath and lane closure to complete. The trial pit has now been backfilled, and the barriers removed.

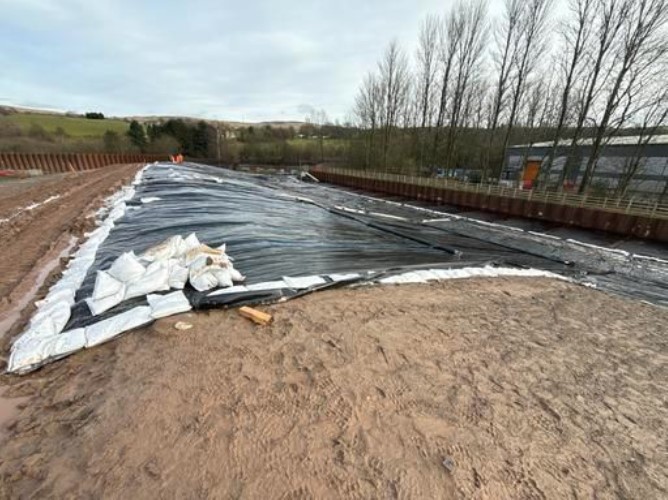

Visqueen cover laid to manage silt

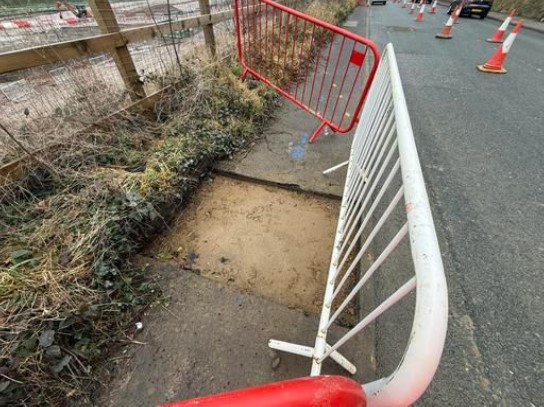

Trial pit on Todmorden Road has been filled after completion
November 2025
Gale West River Diversion works
Persistent and heavy rainfall throughout October has resulted in unsuitable ground conditions, causing delays to the planned infill works on the existing River Roch channel. The construction team plans are to continue filling the channel and installing drainage systems when there is better weather for these activities. They will monitor forecasts closely to decide the best time to resume work and will keep affected residents informed.

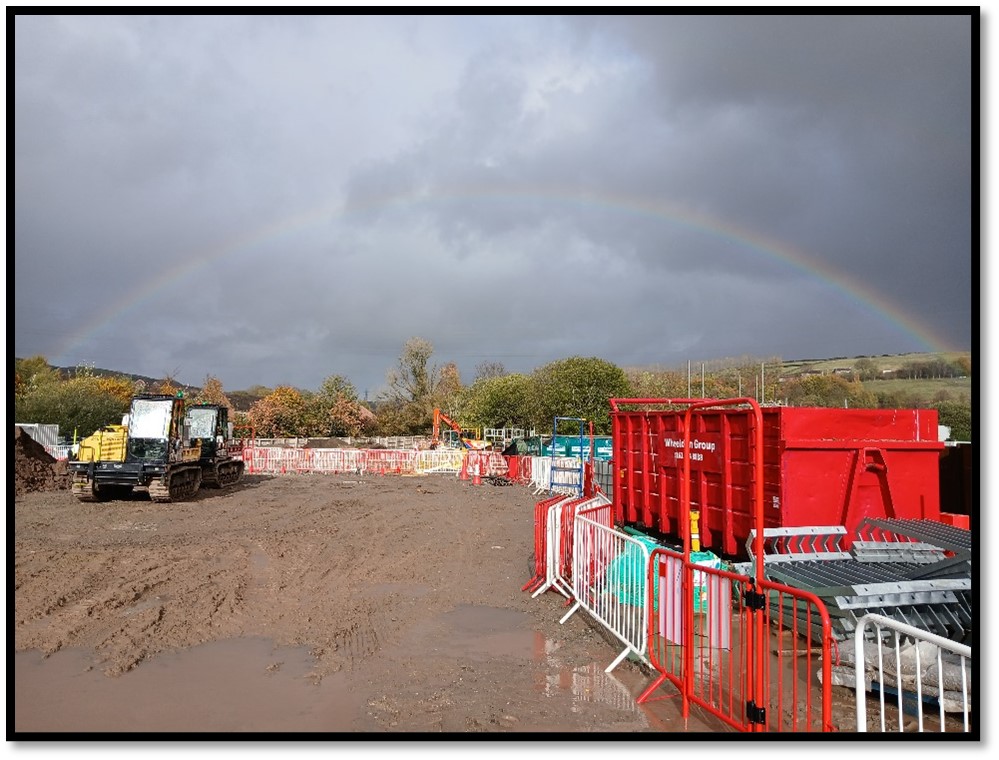

Rainbow over Gale West Site
Gale West gabion basket installation
The team is almost finished installing the gabion baskets at the north end of Gale West site and adjacent to the railway line. These baskets will form an earth retaining structure to supports the maintenance track that runs around the dry side of the reservoir. The track rises over the eastern sheet pile wall at its northern end before leading into the turning circle which provides access into the reservoir. The area highlighted in orange indicates the location of the works.

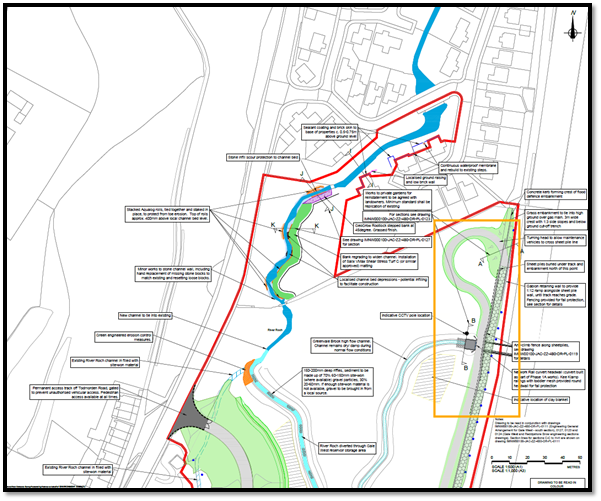

Location of gabion baskets in the Gale West site

Gale West: Gabion Basket Installation Along East Elevation Adjacent to Railway
Gale West reservoir inlet structure (Network Rail Culvert)
The reinstatement of the surrounding ground at the Gale West reservoir inlet structure is now complete. In addition, the final concrete works have been successfully completed.
October 2025

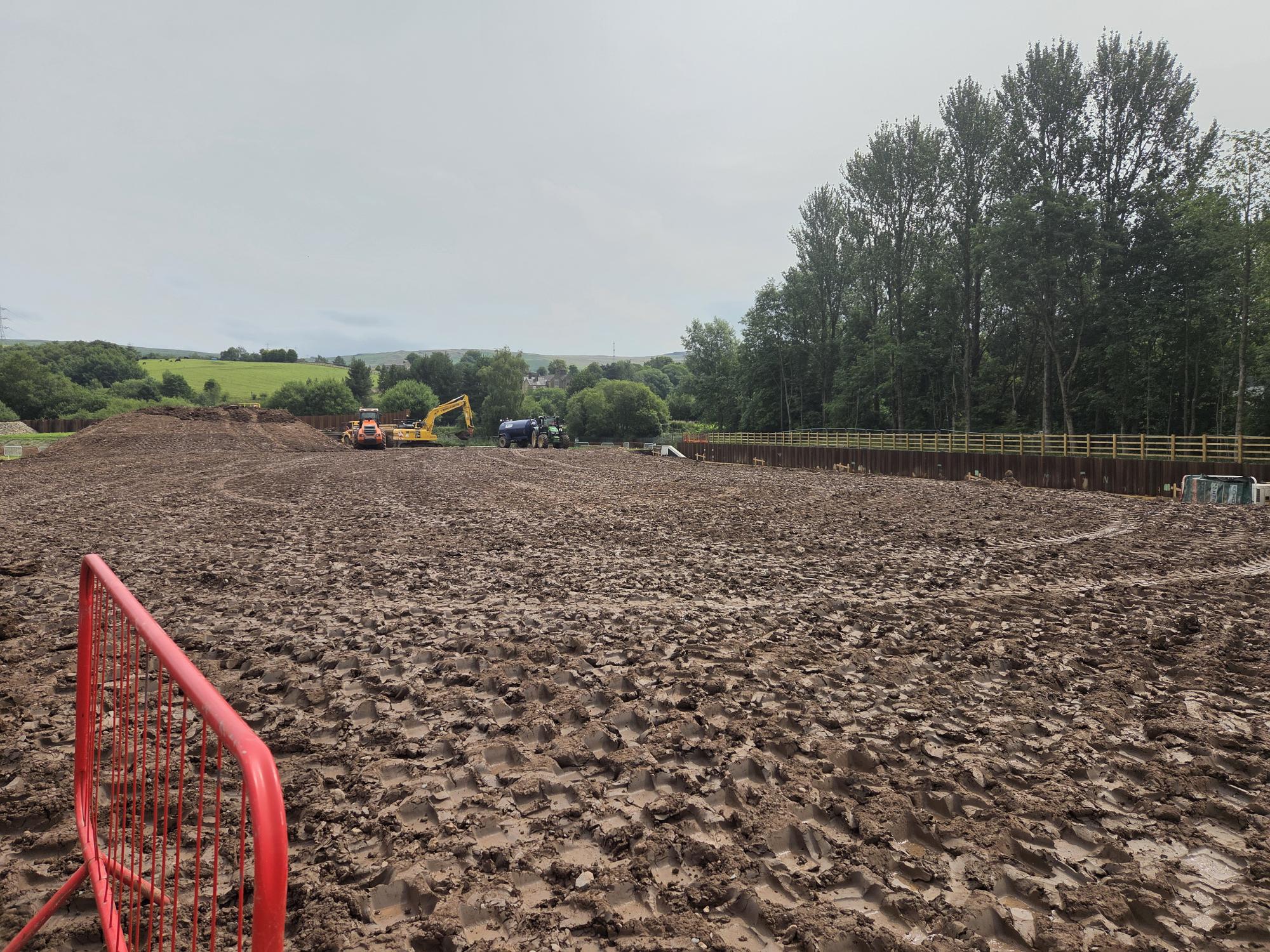

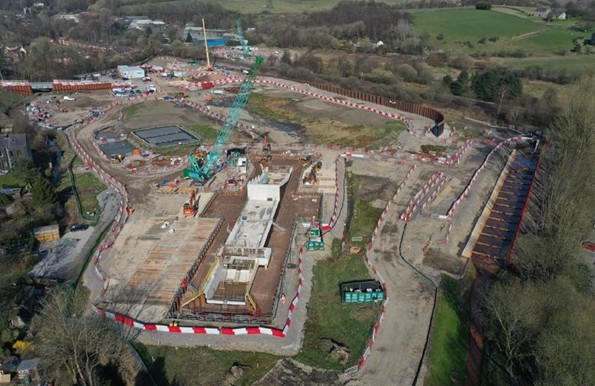

Aerial photo of construction progress of Gale West
Gale West reservoir outlet structure

Aerial view of construction progress on the south side of Gale West
Gale West Embankment Construction
The construction team have continued earthworks to form the reservoir embankments. Around 3,400m³ of material was placed on the south embankment (beside Greenvale Business Park) and over 5,500m³ on the west embankment (beside Todmorden Road) this month. Embankment works are now been finished for the year and will recommence in Spring when better weather returns.
The construction team are installing gabion baskets along the east elevation (beside the railway line). The gabion baskets form a retaining wall which will help divert high water flows to the spillway channel located at the south end of the Gale West site. Progress has been steady, despite challenging weather conditions over the past month.

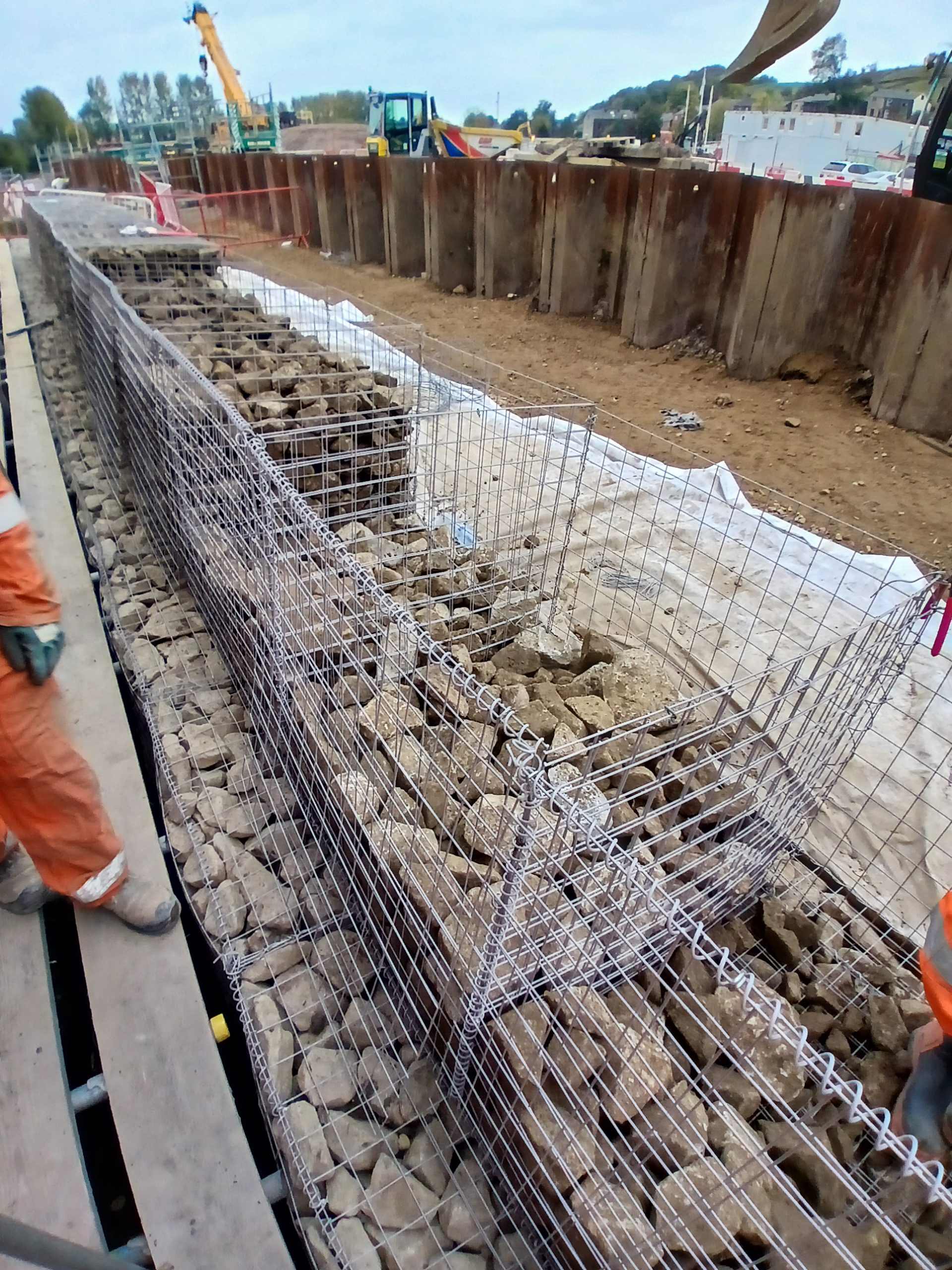

Installation of gabion basket on the east side (beside railway line) at Gale West
River diversion
The construction team have successfully completed the downstream river diversion.

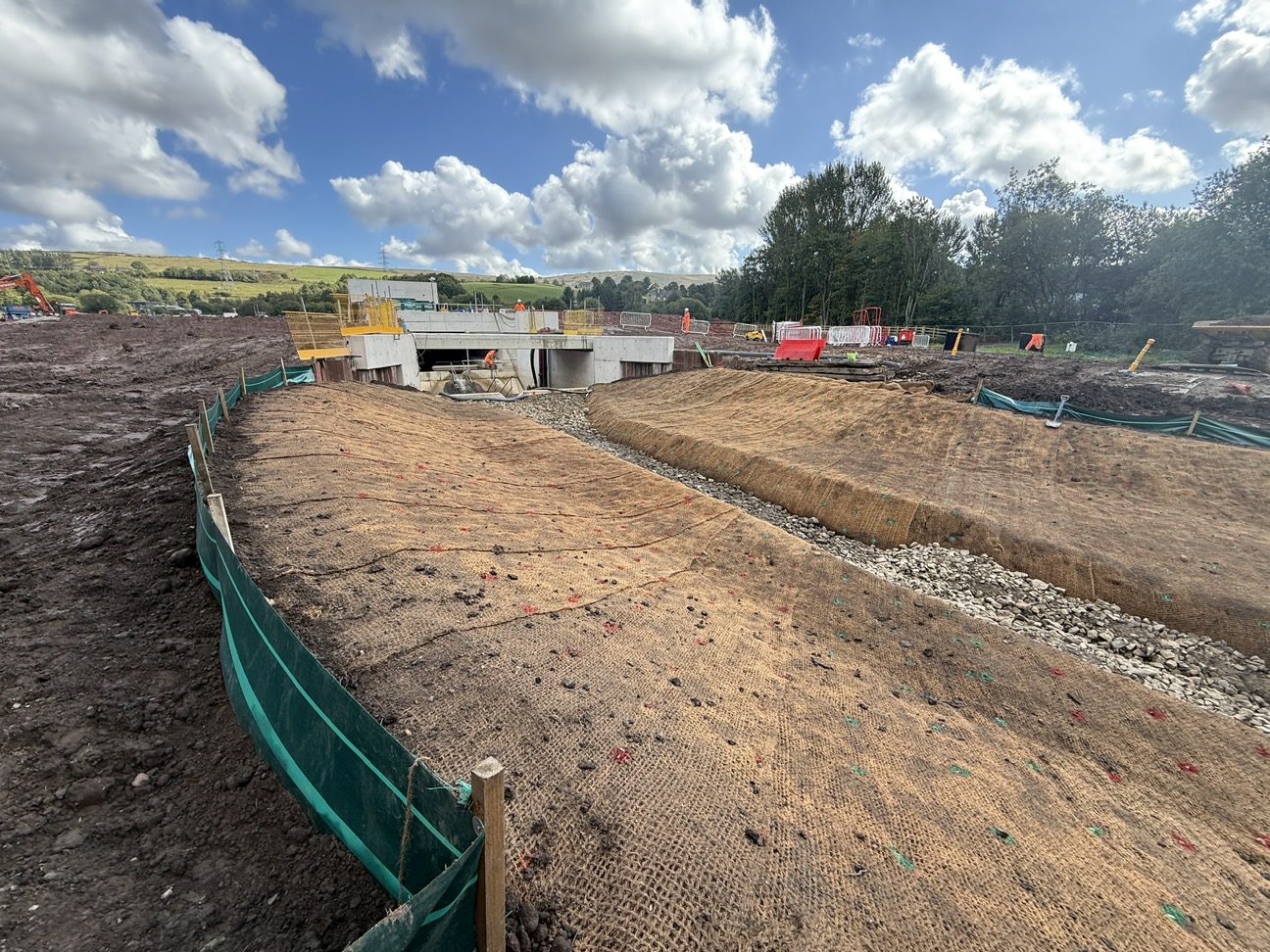

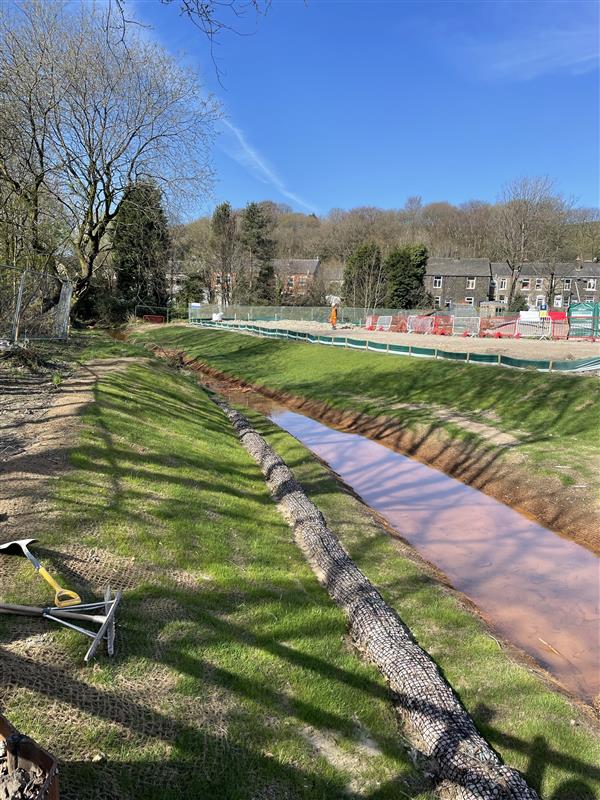

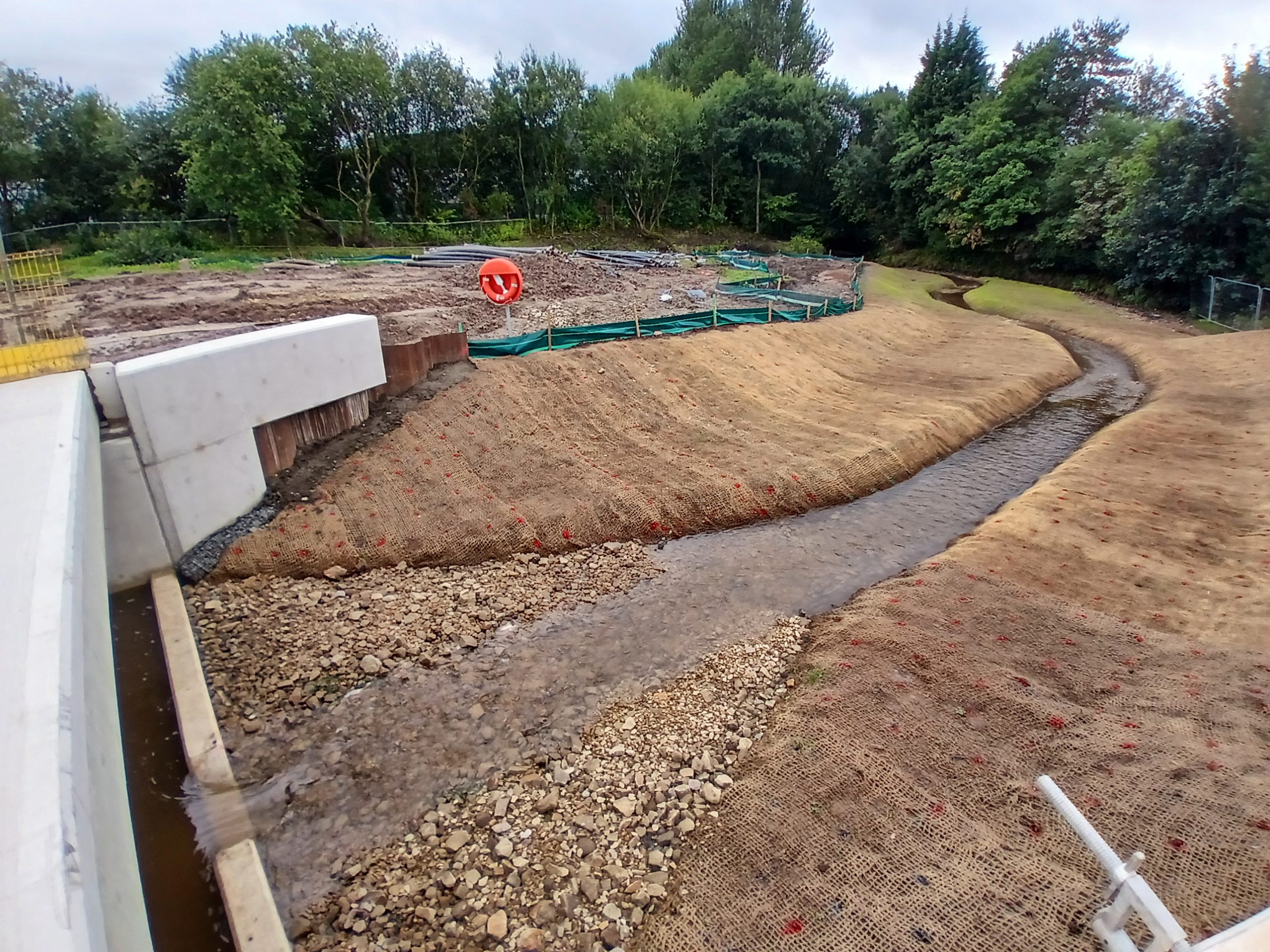

Completed downstream River Roch diversion

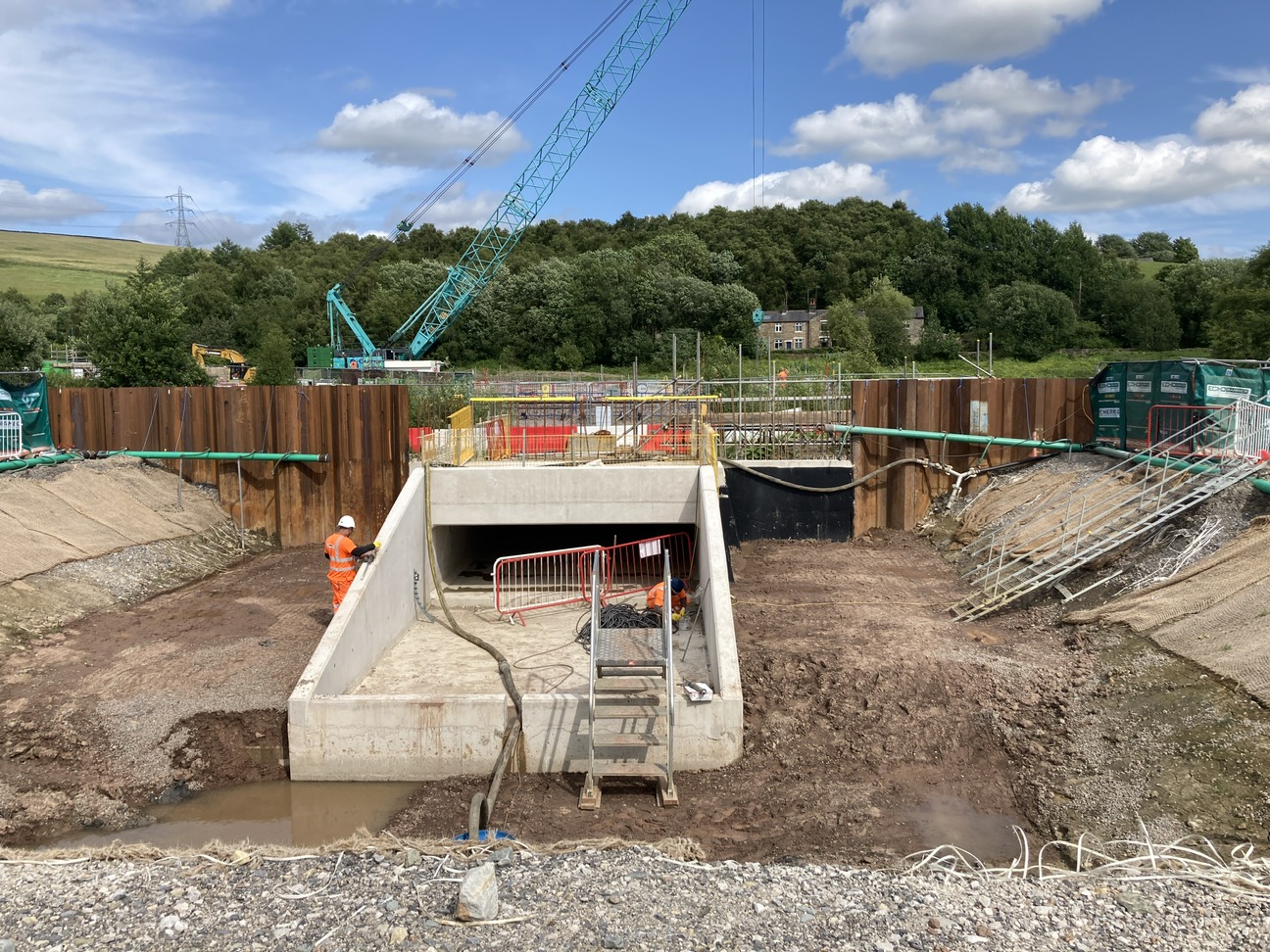

Gale West reservoir inlet structure (Network Rail Culvert)
The Gale West reservoir inlet structure is now complete, and reinstatement of the surrounding ground is ongoing.
The construction team are progressing with the concrete works to the interface between the culvert and the sheet pile wall.
September 2025
Gale West reservoir outlet structure
| The ground levels over the reservoir outlet structure have been reinstated as the culvert construction is completed. |
Gale West embankment construction
| Work continues to install the earth embankment which will retain the flows within the reservoir. The earthworks on the southern part of the site is nearly at the top level and this will be followed by construction along the western part of the site. The earthworks operations are weather sensitive and will be paused in the autumn to resume the following spring. |
River Diversion
| The team has successfully connected the new River Roch diversion channel to the Gale West reservoir outlet structure. In advance of the diversion works, a fish rescue was carried out, with over 2,000 fish recorded in the R. Roch, including species such as stickleback and brown trout. The large number of fish is a good indication that the watercourse is healthy. All the fish were safely relocated to another section of the River Roch.
The new R. Roch channel is now active, and the team will begin to infill the existing river alignment. This new river alignment moves flows into the flood storage reservoir basin and downstream flow into Littleborough will be controlled via the reservoir outlet structure. |

Image shows Completed downstream River Roch diversion channel
Gale West reservoir inlet structure (Network Rail culvert)
| At the reservoir inlet structure, which connects to the Network Rail culvert and diverts flows from Gale East into Gale West, concrete works are now complete. Over the next few weeks, the construction team will begin reinstating the ground around the inlet structure. |
July 2025
Gale West reservoir outlet structure
| The construction team have continued to build up the ground levels around the concrete structure of the reservoir outlet. The construction team have also taken out the temporary piles (known as cofferdam piles) that helped with building the structure. A metal ‘trash’ screen has been put on the front of the outlet to catch leaves, branches and rubbish during heavy rain. The construction team will continue building up ground levels over the summer. |

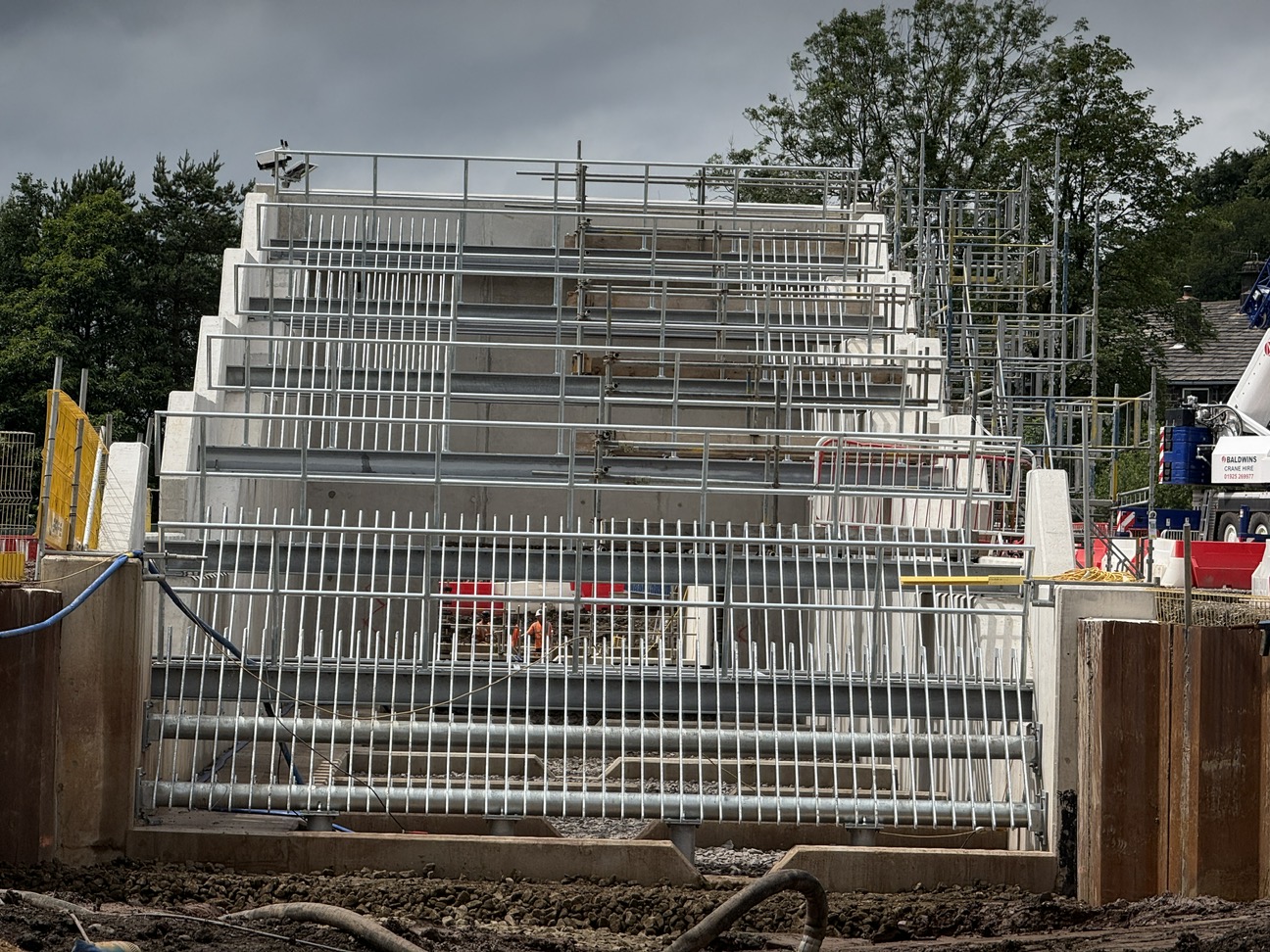

Installation of trash screens on the reservoir outlet structure
Gale West reservoir inlet structure (Network Rail culvert)

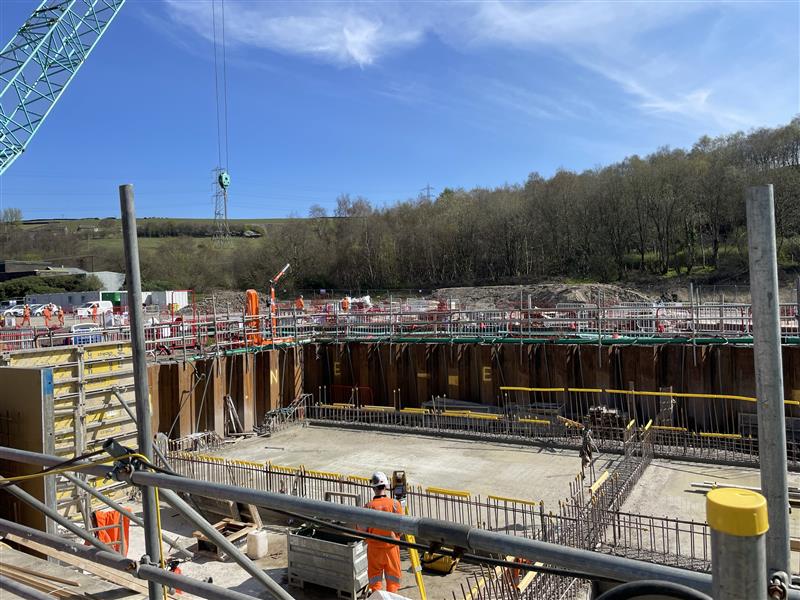

| Work has also continued the Gale West reservoir inlet using reinforced concrete (an inlet is a narrow passage that directs water). The inlet forms part of the culvert extension underneath the railway embankment and connects both sides of the reservoir, helping water flow between them. Progress has been slow as the construction team have discovered newts in this area, which is currently being mitigated for. Next steps are to backfill this structure with clay over the summer. |

Gale West reservoir inlet structure
Gale West access
| At the north end of Gale West, near Shottwood Fold, the construction team have started laying clay. This clay will become the access path for maintenance vehicles to reach the reservoir. |

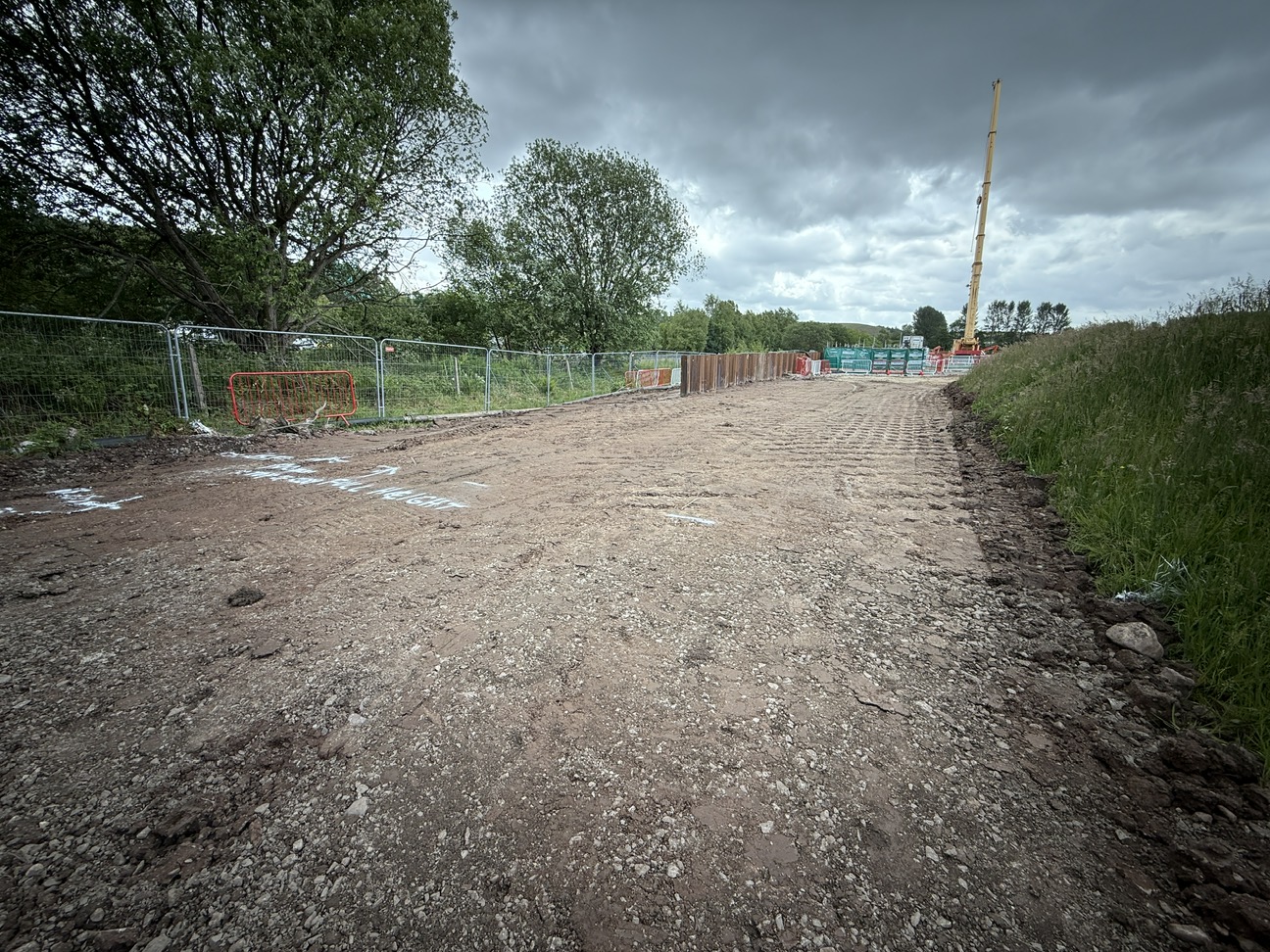

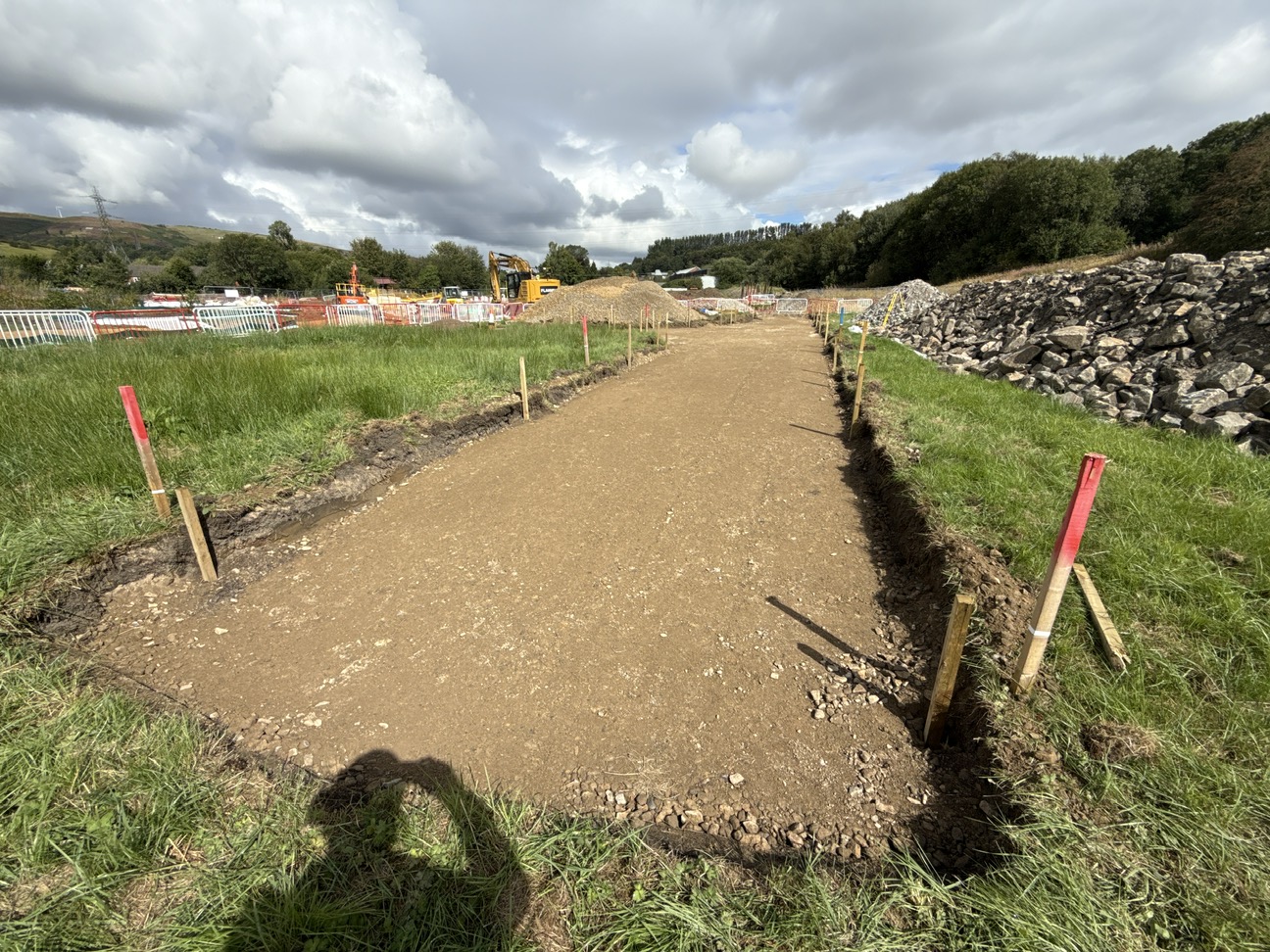

Clay layer being compacted for the access track
Embankment Works
| Work is continuing on the clay embankments along the south side (next to Greenvale Business Park) and the east side (next to the railway) of Gale West. The clay is being placed and compacted in layers, and when complete the embankments will create the boundary of the reservoir area. The work to lay and compact the clay will continue over the summer. As planned, work will stop here over the winter due to wet and cold weather and resume in spring the following year. |

Clay compaction for the south embankments
River Diversion

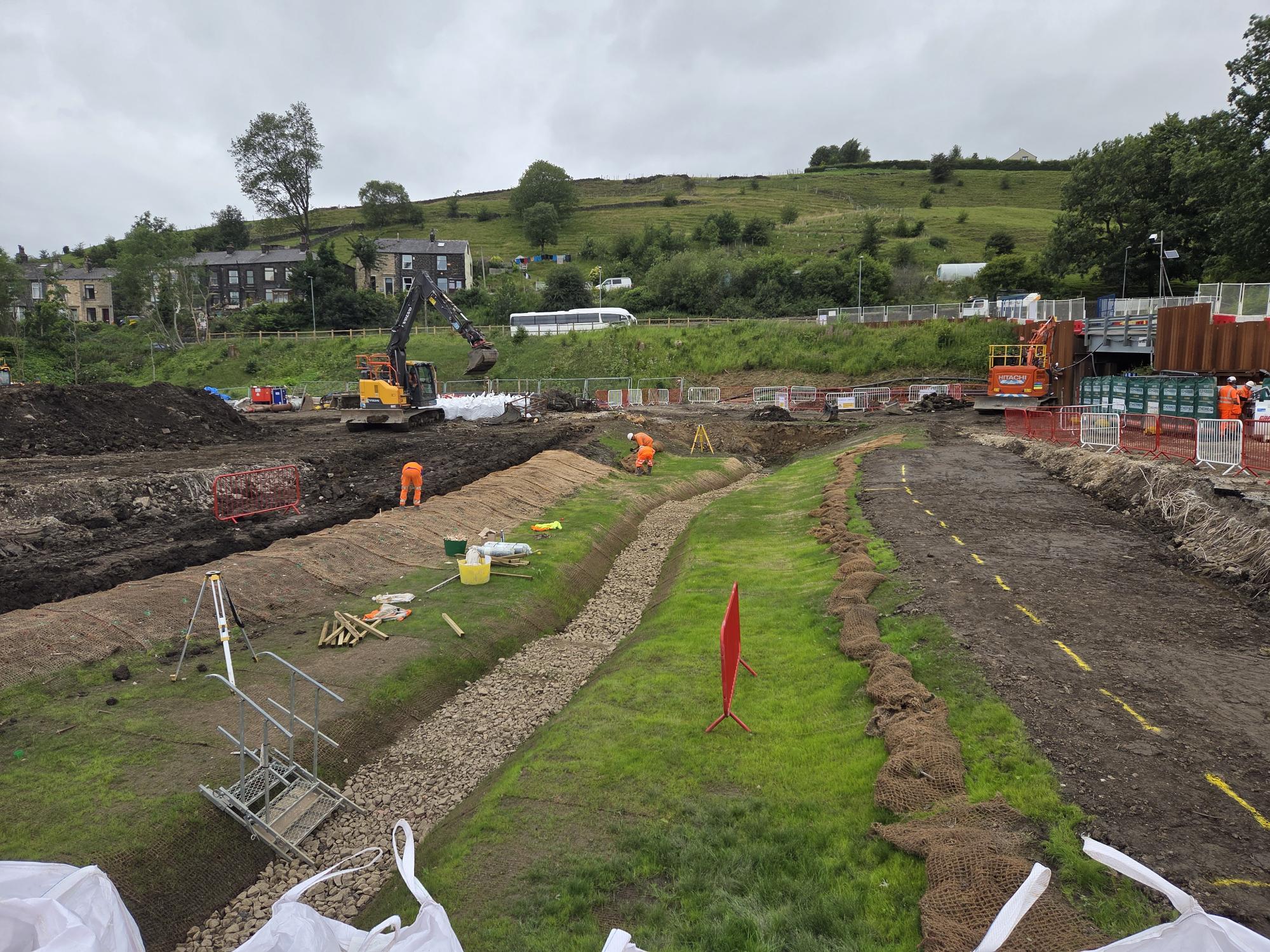

| Construction of the new channel for the River Roch is underway. Once complete, water from the old River Roch channel will be diverted into this new channel and then flow into the reservoir. The same will be done for Greenvale Brook, guiding it into the reservoir through the Gale East diversion structure. The new river channels are designed to be wide and will be lined with coir matting (made from coconut fibres). This matting helps reinforce the channel and prevents the soil washing away while the grass is growing.
Construction of the channel will continue until October, before the fish spawning season starts. |

River Roch new channel diversion (Todmorden Road end)

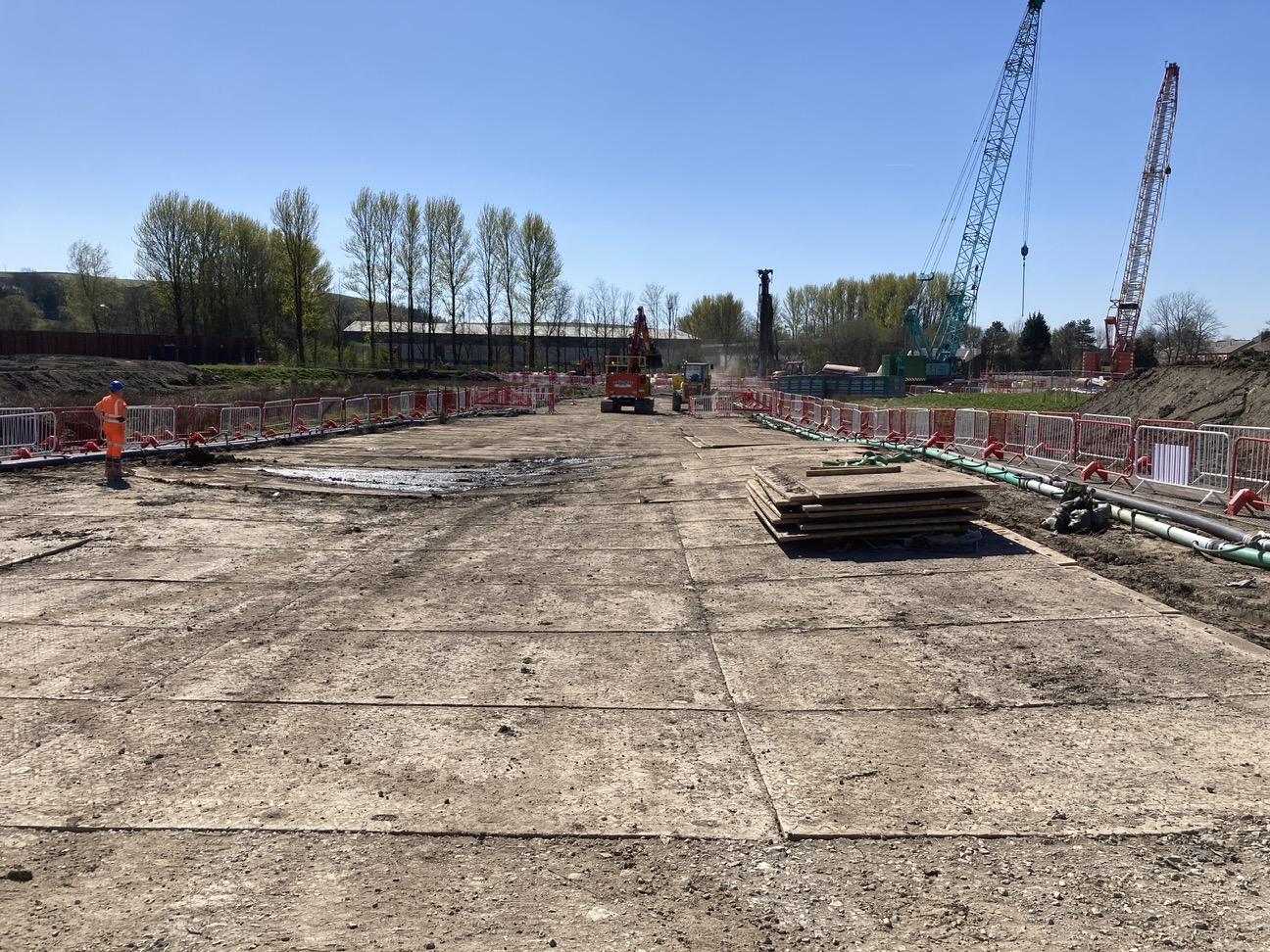

River Roch new channel diversion
| To complete the works within the channel, the construction team will need to temporarily divert flows in the River Roch. But before the river flows are moved, the fish need to be rescued. A specialist team helped the construction team to move over 200 trout (final number to be confirmed) safely downstream in the River Roch. |
April 2025
Littleborough Phase 1a
Riverstone Bridge
At Riverstone Bridge the permanent fencing has been installed and landscaping works are complete.

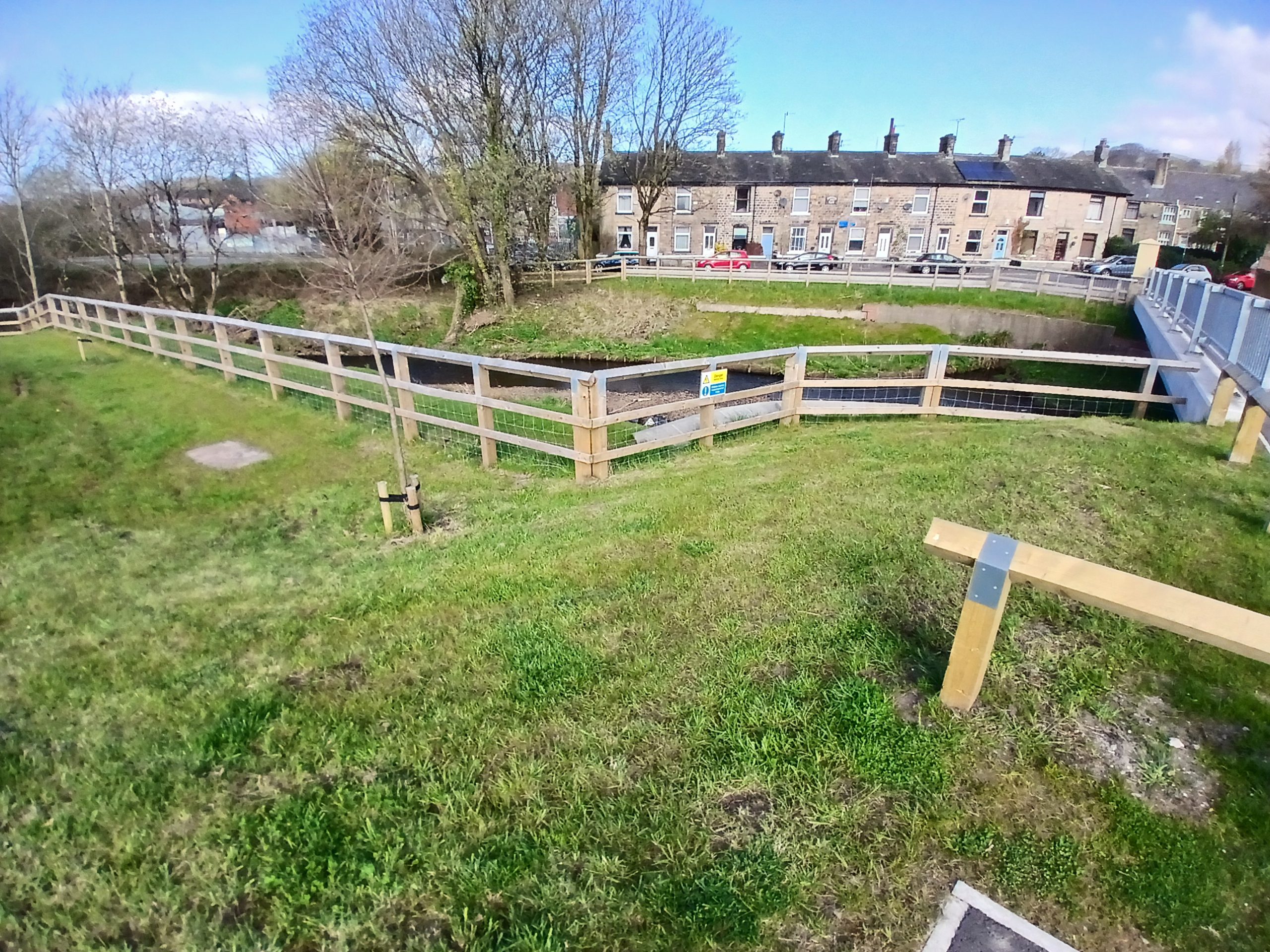

Fencing at Riverstone Bridge
Littleborough Phase 1b

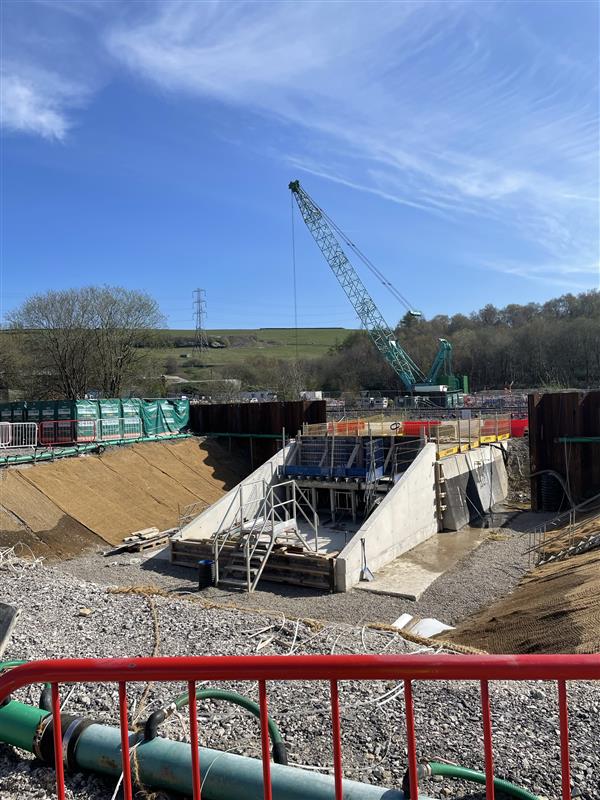

| At the Gale West reservoir outlet structure, the concrete works to form the culvert and headwall are now complete. The Contractor is backfilling around the outlet structure (85% complete). They are also removing the temporary piles of the cofferdam in preparation for the embankment works that will form the reservoir boundary. It is expected that the temporary piles removal will be completed by the end of the month. |

Gale West reservoir outlet structure
| The Contractor have begun the River Roch diversion preparation works which involves excavating a new channel. The new channel will direct flows through the reservoir and through the reservoir outlet structure which will be the flow control. The existing Roch channel will be filled in and a pipe installed to convey surface water drainage. |

Preparation works for River Roch diversion

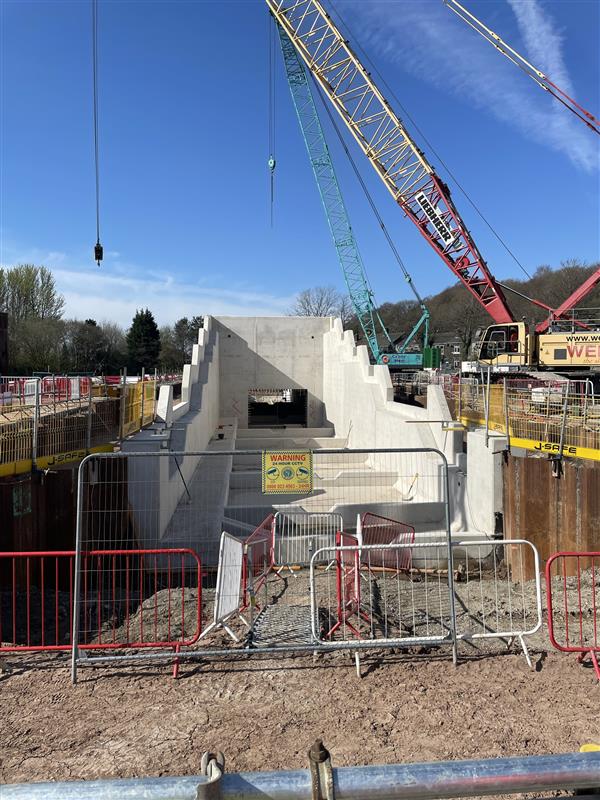

| At the Network Rail culvert, the remaining concrete works for the reservoir inlet structure are almost complete. In operation, during a high flow event, water from Gale East will be diverted through this structure and into the main Gale West reservoir basin. |

Construction of the Gale West reservoir inlet structure beside the railway
| At the spillway stilling basin, landscaping works are currently underway, which includes the levelling of ground at the rear of the piles and grass seeding. Gabion baskets are also being installed, forming a wall that will help channel flows during an exceedance event. These works are expected to be completed by the end of April. |

Gale West Spillway
February 2025
Littleborough Phase 1a
At Riverstone Bridge, the Heras fencing has been removed, some minor landscaping works are still to be completed. This includes replacement of some of the dead trees.
Littleborough Phase 1b
Please refer to the colour coded map of the Littleborough Ph1b site that corresponds to the text in the monthly updates

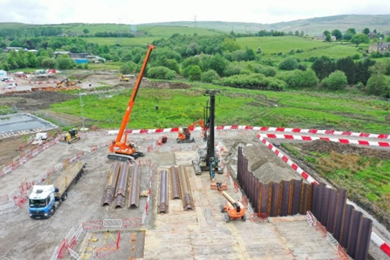

At Gale West, alongside the railway line, the Contractor is progressing the construction of the culvert beneath the railway which will connect the Gale East storage and Gale West storage.

Gale West railway line diversion culvert
| At Gale West outlet structure. construction is ongoing and is about 80% complete. |

Gale West reservoir outlet structure stilling basin
| At Gale West along the railway line, a 500T crane will be lifting precast concrete culvert sections into the cofferdam to extend the existing railway culvert into the reservoir area. |
March 2026
At Gale East, our team have resumed the embankment construction works with the construction of the reservoir spillway.
November 2025
Gale East embankment construction
Over the past month, the construction team made good progress on the west embankment works. Due to weather, the earthworks at Gale East are on hold. The location of the works is highlighted in orange below.

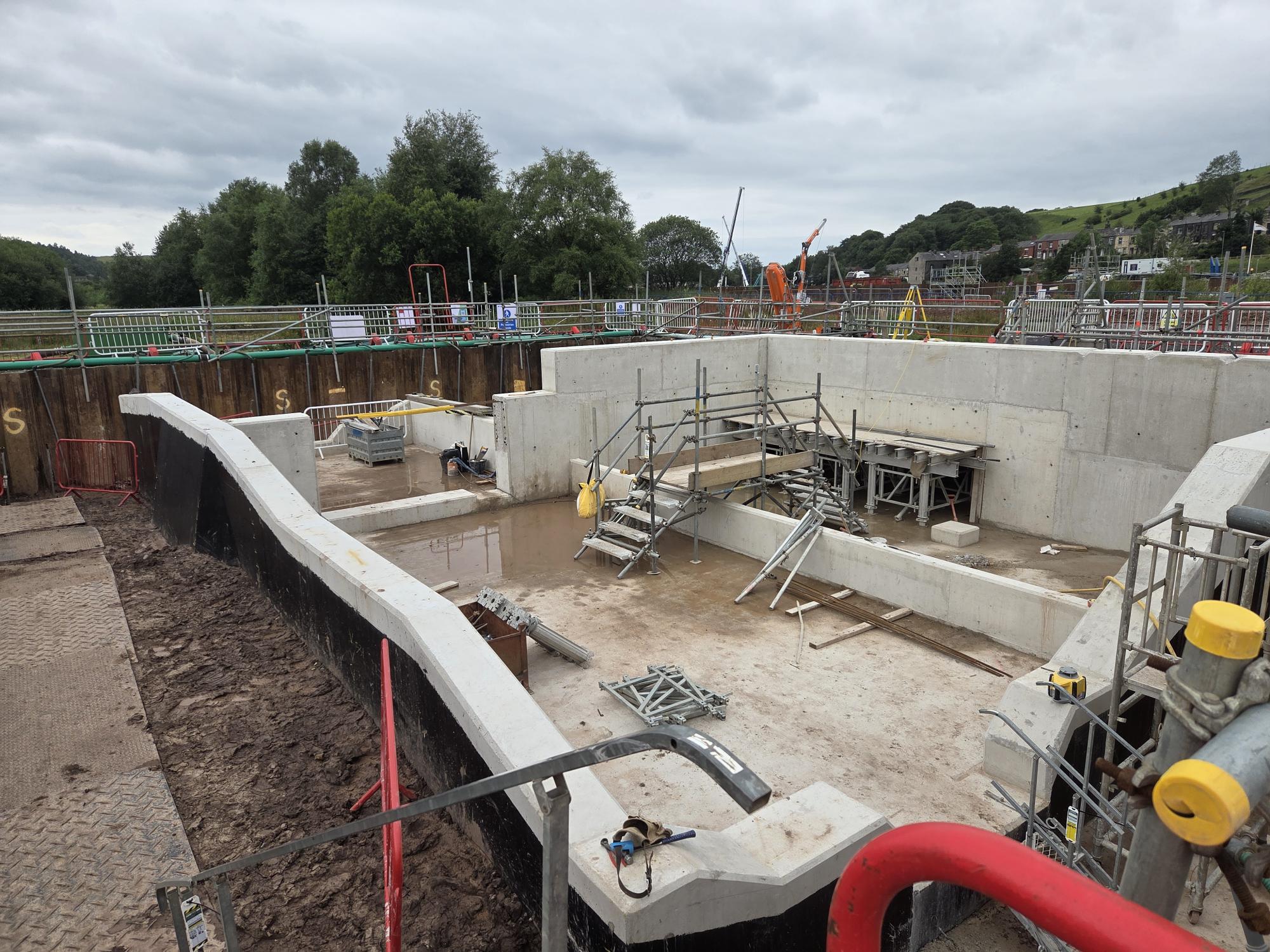

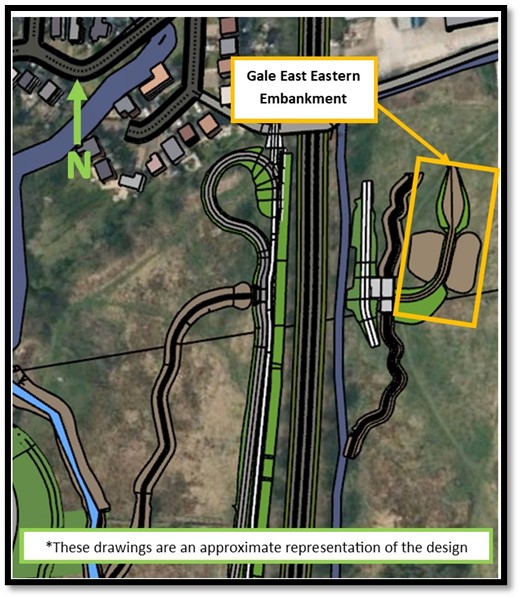

Location of the works at Gale East
Greenvale Brook river diversion at Gale East
Construction works on the new Greenvale Brook channel has been completed. The over pumping system has been removed, and the Greenvale Brook flow has been resumed.

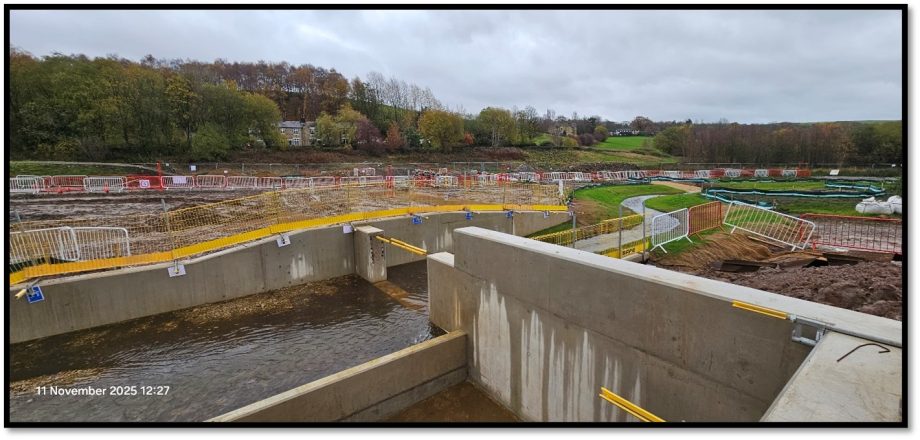

Gale East River Diversion Structure

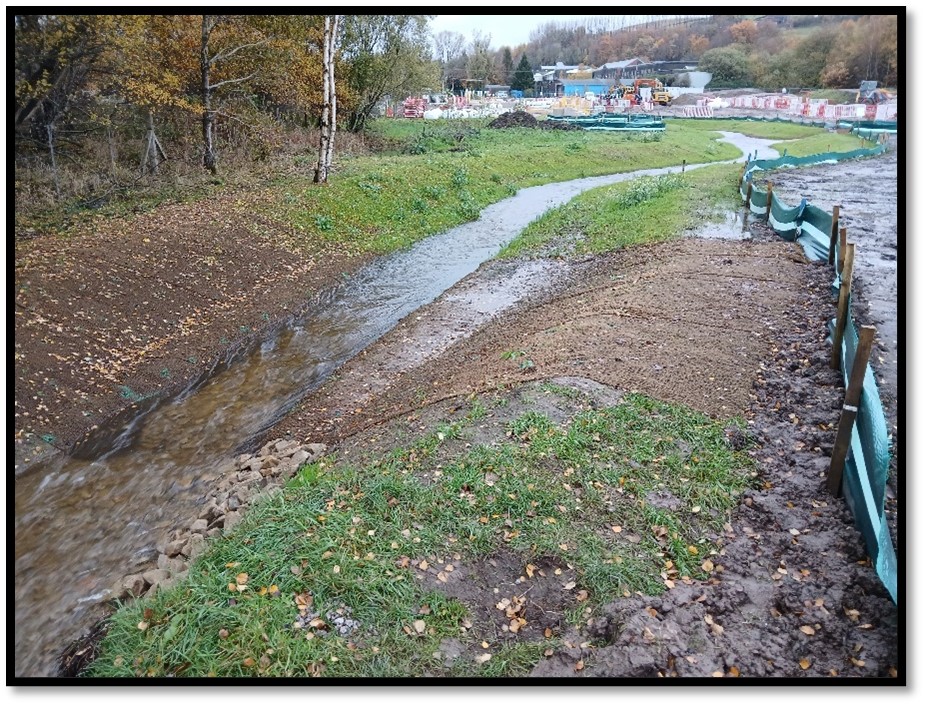

Resumed Greenvale Brook channel flow
Gale East access track
In the coming month, the construction team will begin work on the access track at Gale East, including the turning head. This feature is designed to allow maintenance vehicles to turn safely during inspections and routine maintenance.
October 2025

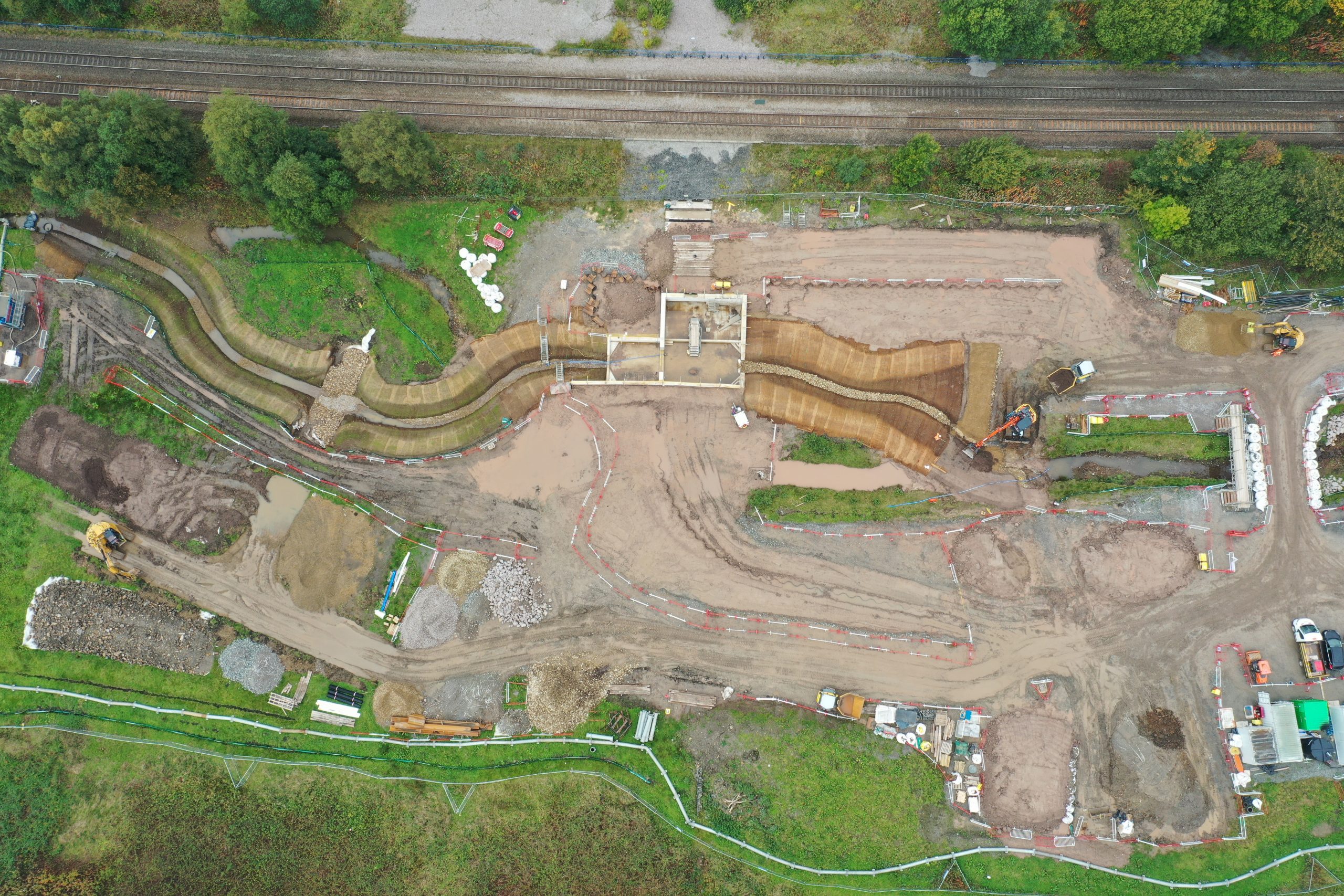

Aerial photo of construction progress at Gale East
The construction team have progressed with the Gale East diversion structure and embankment cut-off piles, which are now fully installed.

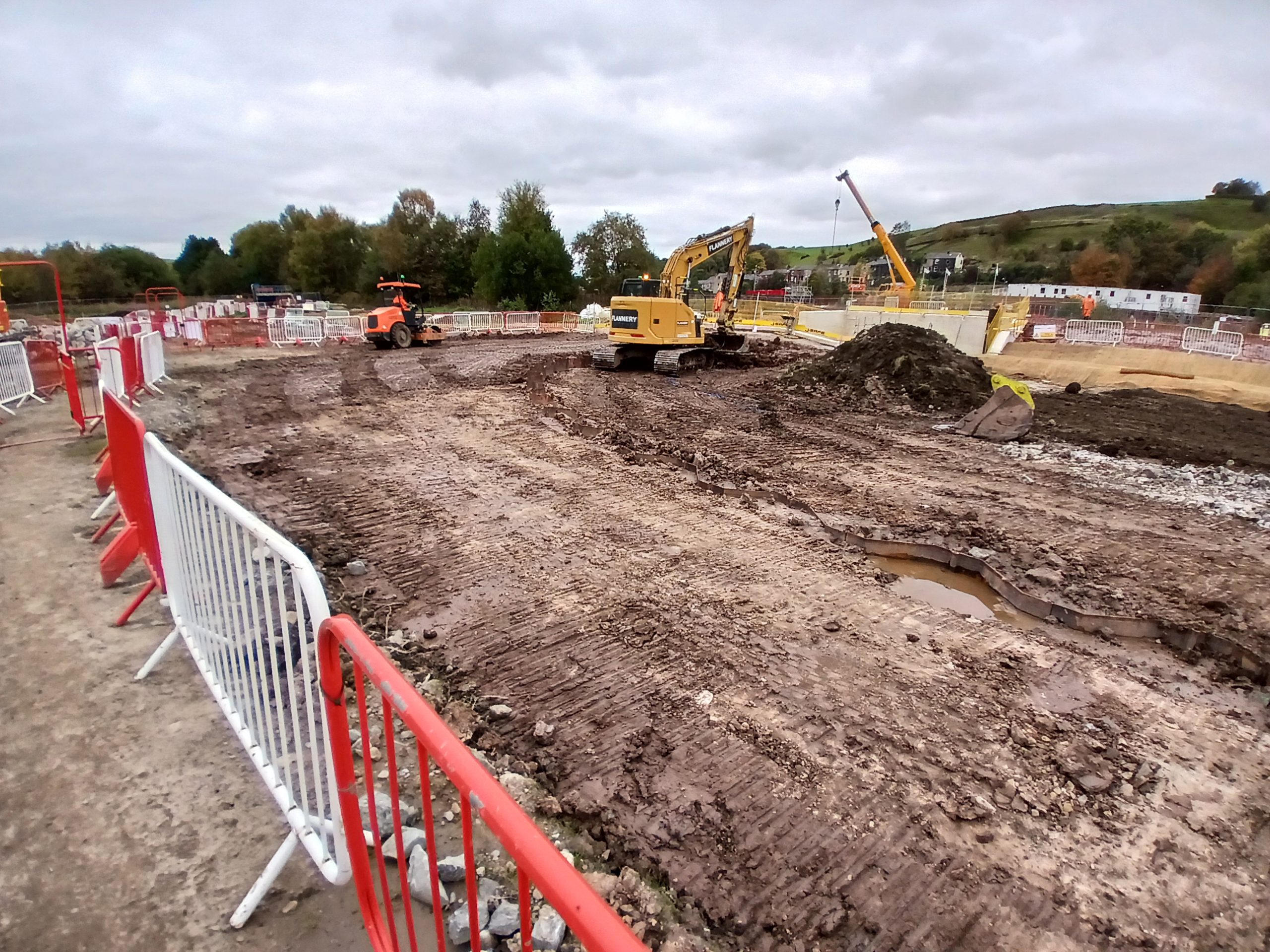

Construction of the Gale East embankment
The connection to the downstream channel is now complete, and work has started on the upstream part of the Greenvale Brook river diversion. The construction team will be progressing with the access track alongside final works to the upstream river diversion. The access track will allow maintenance of the diversion structure and embankments once the flood storage basin is complete and operational
September 2025
At the Gale East diversion structure which diverts flows from Greenvale Brook into the culvert under the Network Rail track, concrete works have been completed. As such the construction team is now removing the temporary piles that formed the cofferdam installed to create a safe working area. The construction of the metal trash screen can progress when the area has been cleared.
Around the diversion structure work is ongoing to realign the Greenvale Brook channels. The new channel is designed to direct flows into the diversion structure.

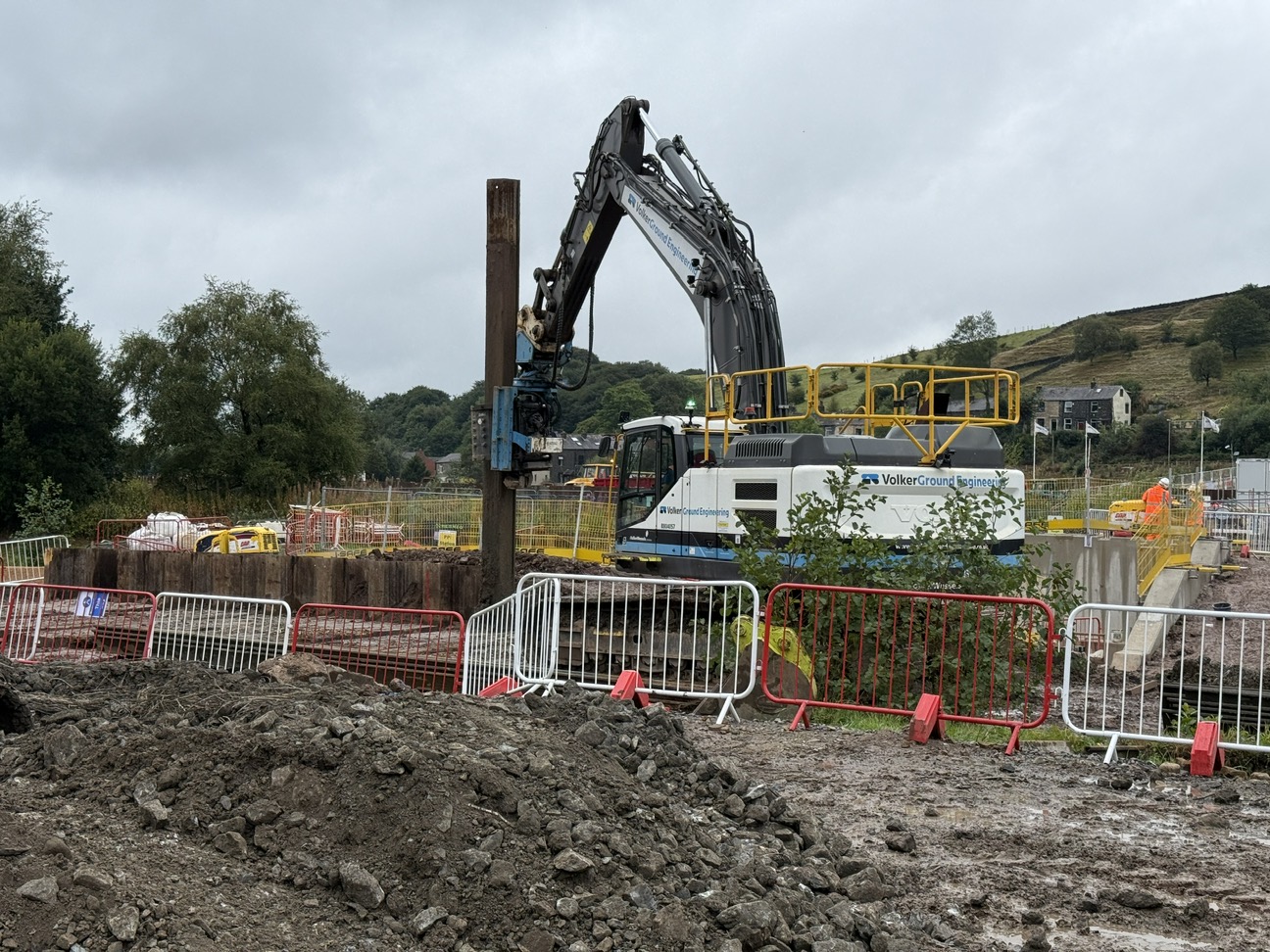

Image shows Cofferdam piles being removed at Gale East
Alongside the network rail track, the team have started installing cut off piles which will prevent seepage through the embankment once the reservoir is operational.
Over the coming weeks, the construction team will be installing the permanent access track for the operation and maintenance of the Gale East reservoir.

Image shows installation of the access track
July 2025
At Gale East, the construction team have nearly completed the concrete works at the upstream end of the diversion structure located beneath the railway. Work has now started on backfilling the excavation area.
The construction team will continue backfilling of this area and finish the detailing of the concrete works over the summer.

Concrete works at the Gale East diversion structure
April 2025
At the Gale East diversion inlet structure, the Contractor are progressing with concrete works. They have poured the base slabs and are now constructing the walls, which will, in future, divert water through the Network Rail culvert into the main Gale West reservoir storage basin.

Gale East diversion structure
February 2025
At Gale East, for the diversion structure, the cofferdam has now been excavated and formed to create a dry working environment. Piling works within the cofferdam have commenced. This is to prevent seepage under the diversion structure. The Contractor will install the clay cut off for the diversion structure.
November 2025
April 2025
The Contractor has been pollarding trees ahead of plans to remove the trees later this year. Removing the tree branches now will prevent birds from nesting here before the trees are taken out.
The Contractor has also completed additional trial holes along the footpath in advance of the creating of the access road from Todmorden road to construct the Centre Vale flood defences. These trial holes were necessary to determine the depth of buried services and allow a temporary works service protection design to be completed.
November 2025
April 2025
The Contractor has been pollarding trees ahead of plans to remove the trees later this year. Removing the tree branches now will prevent birds from nesting here before the trees are taken out.
The Contractor has also completed additional trial holes along the footpath in advance of the creating of the access road from Todmorden road to construct the Centre Vale flood defences. These trial holes were necessary to determine the depth of buried services and allow a temporary works service protection design to be completed.
March 2026
The access ramp into the site has now been fully modified to accommodate the crane and other equipment required for the upcoming piling works, and all temporary traffic management measures have been removed.
A new piling platform is being put in place, which will allow a stable level surface from which engineers can safely install the permanent sheet piles which will form the flood defence structure parallel to the railway line.
November 2025
October 2025
At Grove Lodge, the construction team are progressing with temporary works design in preparation for the works.
September 2025
The team plan to start works at Grove Lodge and will shortly be importing stone to the area to create the construction working platforms. The stone deliveries will take place on the Thursday 11th September for around 5 weeks to create a piling platform in preparation for piling works along the railway line. Please refer to our Grove Lodge letter under the ‘Newsletters, news and events’ tab for more information.
April 2025
The Contractor has completed all enabling works.
February 2025
At Grove Lodge, tree clearance works commenced from 4th February to 14th February. A footpath diversion was put in place during these works.
March 2026
Earlier in the year the project team undertook planned vegetation clearance and survey works near GNG Foam Convertors, off Todmorden Road.
These surveys are an important part of the design process for the scheme and help identify any underground services in the area. This information will help us plan the construction of a new flood defence wall along the left bank of the River Roch at GNG Foam Convertors, expected to be built later in the summer.
March 2026
The construction of the erosion‑protection measures within the watercourse, which began last year, can now be completed thanks to the improved weather conditions. Over the coming weeks, the construction team will finalise the riverbank grading work, followed by grass seeding and additional planting along the riverbank. Please be advised that the footpath near Shottwood Fold, across the iron railway bridge, has been re-opened, but the Coronation Walk footpath remains closed to ensure the safety of the public as it is part of the active construction site however it is hoped to have this reopened in the summer.

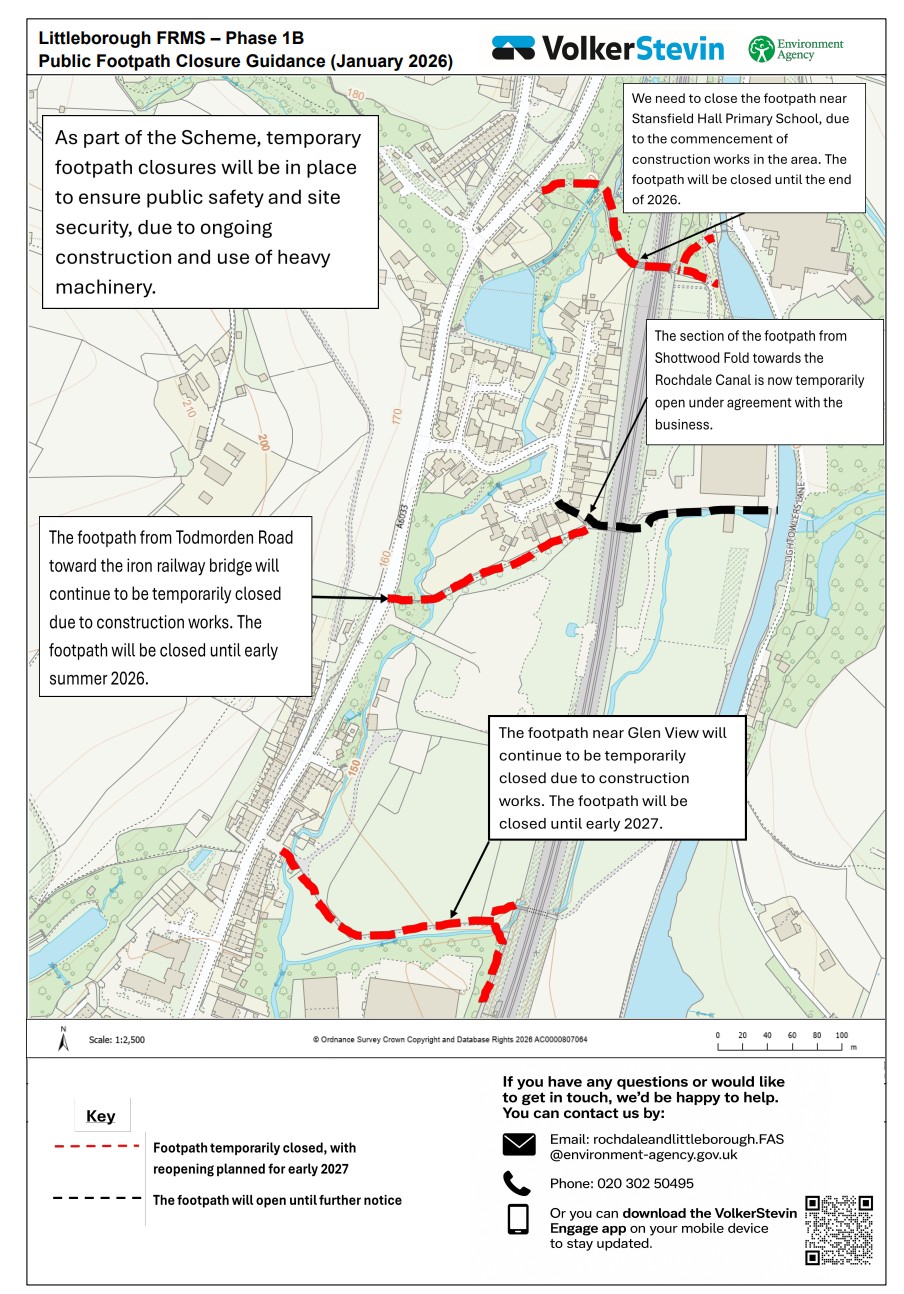

Please see the following link for more information about public right of way closures: https://thefloodhub.co.uk/wp-content/uploads/2026/01/A3-map-full-footpath-closures-Jan-2026.jpg
Following ecological assessment to ensure no presence of birds or bats, the construction team will be removing a limited number of trees near the iron railway bridge. This is to support the creation of the access track turning circle for maintenance vehicles serving the Gale Flood Storage Reservoir and tie the flood defence levels into higher ground by the bridge.
November 2025
Shottwood Fold bank stabilisation works
The team has completed reprofiling of the left-hand bank (looking downstream) of the River Roch and carried out bank protection works to stabilise the right-hand bank. During November, vegetation planting will be completed on both the left and right-hand banks. The left-hand bank is to be seeded topsoil and plug planting whilst the right-hand bank will have plug planting and tree whips.

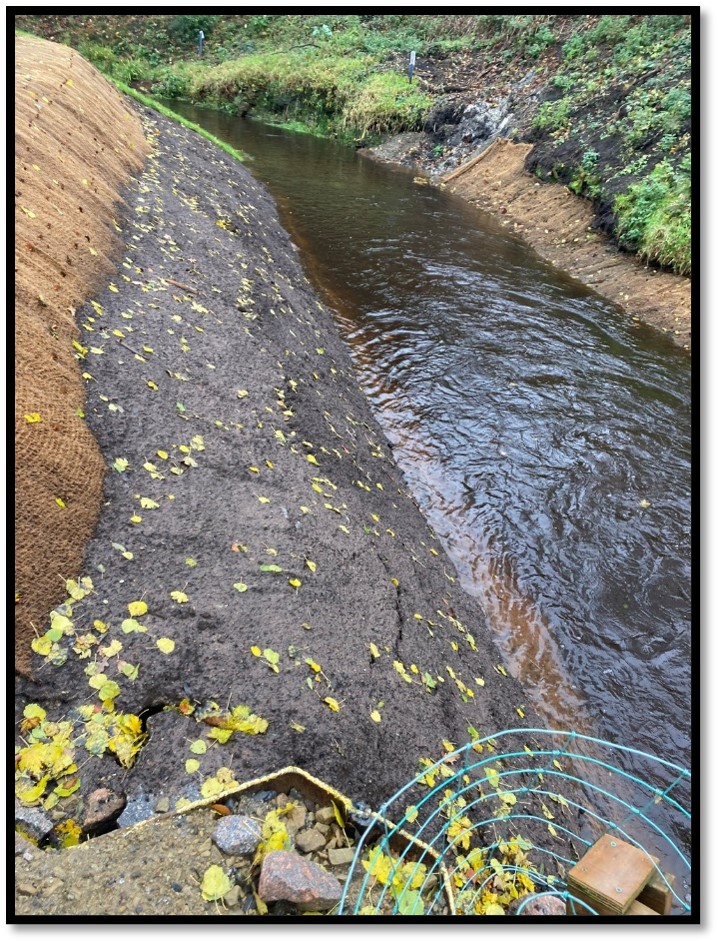

Shottwood Fold: left-hand bank seeded topsoil and plug planting
October 2025
The construction team have progressed with bank protection works to stabilise the right-hand bank of the river. The next phase of works will focus on landscaping works and restoring the surrounding ground.
September 2025
Piling works has been completed which form part of the bank protection along this short section of river channel located immediately upstream of the reservoir. The construction team is now installing erosion control works at the base of the riverbank.
July 2025
At Shottwood Fold, the construction team have started to create a new access path. This will let allow access to the riverbanks to carry out strengthening work.
The next activity will be to start piling in this location and to complete the riverbank reinforcement works. Works need to be complete by October, before the start of the fish spawning season.
April 2025
Final detailed design is nearing completion with construction expected to start in the next few months.
February 2025
At Shottwood fold, tree clearance works have been completed, and construction will commence this summer.
March 2026
As part of the scheme, the team will be constructing a sheet pile wall along south side of the Ealees Brook channel in the vicinity of the Greenvale business park. The project team have been preparing the site for these construction works by clearing vegetation and other objects ready for a site compound to be set up.
Trail pits and boreholes will also be carried out to assess the ground conditions required for the sheet‑piling works. These investigations are expected to take up to five working days which may be affected by weather conditions.
November 2025
September 2024
At Ealees Brook, behind the Canal Wharf, Ground Investigation works have been substantially completed. The results from the Ground Investigation will help the Environment Agency finalise the design and plan the construction.
March 2026
As part of our work delivering the Scheme, the project team are currently undertaking ground investigation surveys behind the Trinity Medical Centre near the River Roch. Surveys are expected to take up to five business days and are dependent on the weather.
March 2026
More than 200 properties scheduled to have Property Flood Resilience Measures will be installed by the end of March 2026. The total programme includes approximately 250 properties in Wardleworth and Littleborough. The measures are designed to reduce the impact of surface water flooding and fluvial flooding. Wet testing is being carried out on flood resistant door sets and flood barriers to check they are resilient to a simulated flood event impacting the property.
Holy Trinity Primary School are receiving new rainwater planters. These planters will create a school rain garden to:
- Collect and store rainwater for school use
- Help teach pupils about water conservation
- Provide vibrant planting opportunities for sensory and biodiversity friendly species
Children at the school will help design and plant the new features, encouraging hands on learning about sustainability.
Rochdale Borough Council are very keen to work with local schools and would appreciate their participation in the project. Please get in touch the team so they can register your interest and work with you further. If the team cannot assist you via the Resilient Roch project, then they may be able to direct you to other helpful work the council is conducting regarding energy efficiency.
If you would like to be involved or would require further information, please get in touch with us on [email protected]
March 2026
Recent months have highlighted strong community engagement, including donation and charity contributions.
The scheme was represented at the Green Summit in Manchester on the 3rd of March as an example of an Environment Agency flood risk management project where low carbon initiatives have been championed. Colleagues from the scheme engaged with the public and other industry professionals to discuss its purpose, our ongoing construction of Phase 1B, and to address questions. With the help of visual aids, including a model Lego display, visitors to the table expressed interest in the scheme and its purpose in reducing flood risk.
In addition, the project team were pleased to invite councillors for a site visit on 29th January to discuss scheme progress and future works.

Local councillors were invited for a Gale West/Gale East site visit on 29th January 2026
November 2025
Alongside progress on the scheme, the Environment Agency are proud to celebrate the positive impact they’ve had within the community:
- Community Engagement Drop-In Session
The Environment Agency recently hosted a drop-in session at the Littleborough site cabins that welcomed more than 30 attendees. It was a great opportunity to assist members of the public, share information about the scheme, and answer their questions directly.
- Donation of wood to the Littleborough bonfire night
The Environment Agency were delighted to donate wood from the scheme to the local cricket club. This wood was used for the Littleborough Bonfire Night event, which brought together many community members for an evening of celebration and connection.
September 2025
A variety of wildlife has been spotted on the Construction site.
- Herons were spotted hunting for lunch along the river.
- Frog and tadpoles were found thriving in the river.
- A fox has been found interacting curiously with the site team
- Ducks have been enjoying a swim in the settlement lagoon on site
- 28 common newts were hand rescued from the River Roch and relocate safely to Grove Lodge.
- Sika Deer were photographed grazing peacefully both during the day and night.
- An oyster catcher nest was found, and it is believed that the eggs have successfully fledged
Conservation efforts
A fish rescue was carried out in the River Roch channel and over 2000 fish were recorded and have been safely relocated.
July 2025
Feel Good Family Picnic at Hare Hill
On Thursday 31st July, the Environment Agency had a stall at Littleborough’s Feel Good Family Picnic at Hare Hill Park, alongside the Resilient Roch project. The EA bought along their ‘Underwater Hazards Tank’ where children were tasked with finding hidden hazards in dirty ‘floodwater’. The activity was a great success and lots of children learned to stay away from flood water in real life! The EA also spoke with Littleborough residents about the progress of the flood scheme and really enjoyed participating on the day.

Environment Agency stall at Littleborough’s Feel Good Family Picnic at Hare Hill Park, alongside the Resilient Roch project.

The Environment Agency’s Underwater Hazards Tank
Japanese Delegate Visit
On Saturday 5th July, the Environment Agency, Rochdale Borough Council and Murphy were invited to a site visit for a number of Japanese delegates, ranging from academics, Japanese government and private business. The visit was arranged by the Department for Business and Trade and was a great opportunity to show the delegates some of the Natural Flood Management and Biodiversity Net Gain which has been delivered in Rochdale, along with showing the visitors the Littleborough Flood Risk Management Scheme. The visit gave a chance to learn a lot about Japanese flood risk management. As well as sharing knowledge and expertise on flood risk management processes in England and the concept of Biodiversity Net Gain, which the Japanese government are researching with the aim of rolling out a similar scheme in Japan.
Japanese organisations who had respresentatives attending on the day were:
- Hokkaido University, River Engineering
- University of Tsukuba, Landscape Architecture
- Public Works Research Institute, River Engineering
- Yamanashi University, River Engineering
- Takenaka Corporation, Landscape Architecture
- National Institute for Environmental Studies, Ecology

Site visit with the Japanese delegates to the NFM projects in Rochdale
Reuse of felled timber donated to local Petrus charity
Petrus have sent the construction team some photos of their lovely nature walk and footpath they have created. This has recently been completed at their Greave House supported housing project in Rochdale, creating a tranquil area for their residents to enjoy.
The walkway has been topped with wood chippings that the construction team donated to them earlier in the year.

Image of footpath created by Petrus
Reuse of Felled Timber within the Community
The construction team are very happy to have delivered our donation of 2 x tonne bags of wood chippings to the Littleborough Allotment Society for them to use on their allotment plots.

Image of wood chippings donated to Littleborough Allotment Society
Institute of Water Rising Stars Programme Site Visit
A few weeks ago, the construction team held a site visit to support the Institute of Water Rising Stars Programme, which is designed to develop the skills of a select group of early career professionals. A small group of 7 visited Littleborough 1b site to learn about our works on the Flood Risk Management Scheme.

Early career professionals

Early career professionals
Gale West Installation of Protective Screens
The construction team are installing protective screens at the Gale West outlet to stop branches, leaves and other debris from entering the culvert and causing blockages.
This upgrade will help with:
- Keeping water flowing smoothly
- Preventing flooding and back ups
- Protecting the river and nearby areas
A smart step toward safer, cleaner waterways!

Protective screen at Gale West
CCS Awards Day at The Mercure Manchester Piccadilly Hotel
The construction team are very happy to announce that VolkerStevin received a Gold Award at this year’s CCS Awards Day!
VolkerStevin were awarded 3 bonus points for demonstrating excellent performance in utilising digital technologies to track and reduce carbon and eco-friendly piling during operations.

VolkerStevin Construction Team at CSS Awards
April 2025
Giving back to the community
VolkerStevin has donated four 1 tonne bags of wood chipping to PIER Incredible Edible Gardens in Rochdale. PIER is part of PETRUS who are a charity supporting the homeless in Rochdale. The Environment Agency will be donating a further six 1 tonne bags of wood chippings to PETRUS with their supported housing projects at Greave House, Rochdale. PETRUS are developing the surrounding grounds and creating a nature walk to enhance support sessions. The wood chippings will be used to cover the footpath.
Furthermore, some of timber that were felled in the scheme have been donated to Stansfield Hall Primary School, who have re-used them in their forest garden for their nature classes. The children have had fun building teepee dens from the branches and are using the log rings as seats.
VolkerStevin has donated new sleeping bags and coats to PETRUS and numerous food boxes were donated to the local community food banks over Christmas 2024.
Rochdale Borough Council held a coffee morning on the Monday 13th January at Oliver Sandring care home on Todmorden road and invited VolkerStevin and the Environment Agency to attend to any local community questions
Littleborough Flood Risk Management Scheme are proud to have hosted the launch of the ‘Constructing Change’ initiative on Wednesday 5th March. This was a collaboration between multiple organisations across the construction sector. It aimed to provide local female students with an experience of the construction industry and insight into what career opportunities the industry has to offer. Female students from Wardle Academy in Rochdale visited the site to gain experience of construction and learn about careers in construction. The day included presentations by contractors VolkerStevin, consultants Jacobs, suppliers Flannery’s as well as the talks from the Environment Agency, AE Yates and JN Bentley.
The scheme also had another school visit held on Wednesday 19th March – Matthew Moss High School who joined us for a Get into construction school site visit. The students were given a presentation on the project and site team members gave a presentation on their roles and how they got into construction, followed by a viewing of the working site area.
March 2025
The Environment Agency have donated four 1 tonne bags of wood chipping to PIER Incredible Edible Gardens in Rochdale. PIER is part of the PETRUS who are a charity supporting the homeless in Rochdale. We will be further donating six 1 tonne bags of wood chippings to PETRUS with their supported housing projects at Greave House, Rochdale. PETRUS are developing the surrounding ground s and creating a nature walk to enhance support sessions. Our wood chippings will be used to cover the footpath. If you are interested learning more or supporting the work that PETRUS do, please refer to their web page.
Littleborough Phase 1b project sustainability achievements
3D Machine Control Technology
To help cut carbon emissions, the scheme is using advanced 3D Machine Control technology during the construction of the Gale Reservoir embankments. This technology reduces fuel use by guiding heavy machinery to work more efficiently.
It works by using sensors and GPS to track the exact position of the equipment in real time. Operators see this information on their screens and can adjust movements to follow the 3D design model precisely. This means less unnecessary movement, lower fuel consumption, and a more sustainable way to build.
Low Carbon Concrete
VolkerStevin worked with its supply chain to create a more sustainable concrete mix. By developing a lower-carbon mix, the team reduced the embodied carbon in the concrete while still meeting all required technical performance requirements. This innovation supports the Environment Agency’s commitment to using concretes with lower carbon footprints and a wider range of cement replacements.
Low/Zero Carbon Sheet Piles
EcoSheetPile Plus were procured, instead of a standard sheet pile, resulting in a carbon reduction of 2,402 CO2e(t). The EcoSheetPile Plus is made in an Electric Arc Furnace using 100% renewable electricity and 100% recycled material.

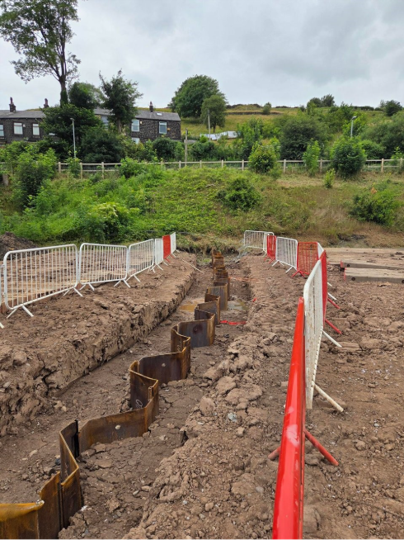

Image showing EcoSheetPiles being installed to create the cofferdam for the Outlet structure
Reuse of Material
The Littleborough FRMS project is delivered in phases enabling scope for re-use of material. The concrete from demolished bridges on Phase 1a has been crushed and reused as part of the haul roads on Phase 1b. This has saved at least 2.31 tCO2e, reduced waste and cut the resources required to be brought in. This allows the implementation of the circular economy approach to material management.

Image showing Charles Bridge Being Removed

Image showing Haul Road where the material was used
Hybrid Machine
The project utilising a 25-tonne hybrid excavator which uses 25% less fuel compared to a standard 25-tonne excavator. Telematics are used to track plant and machinery movements on the site.

Image showing Hybrid Excavator
For more information on work that has been carried out as part of the scheme, please click here.
